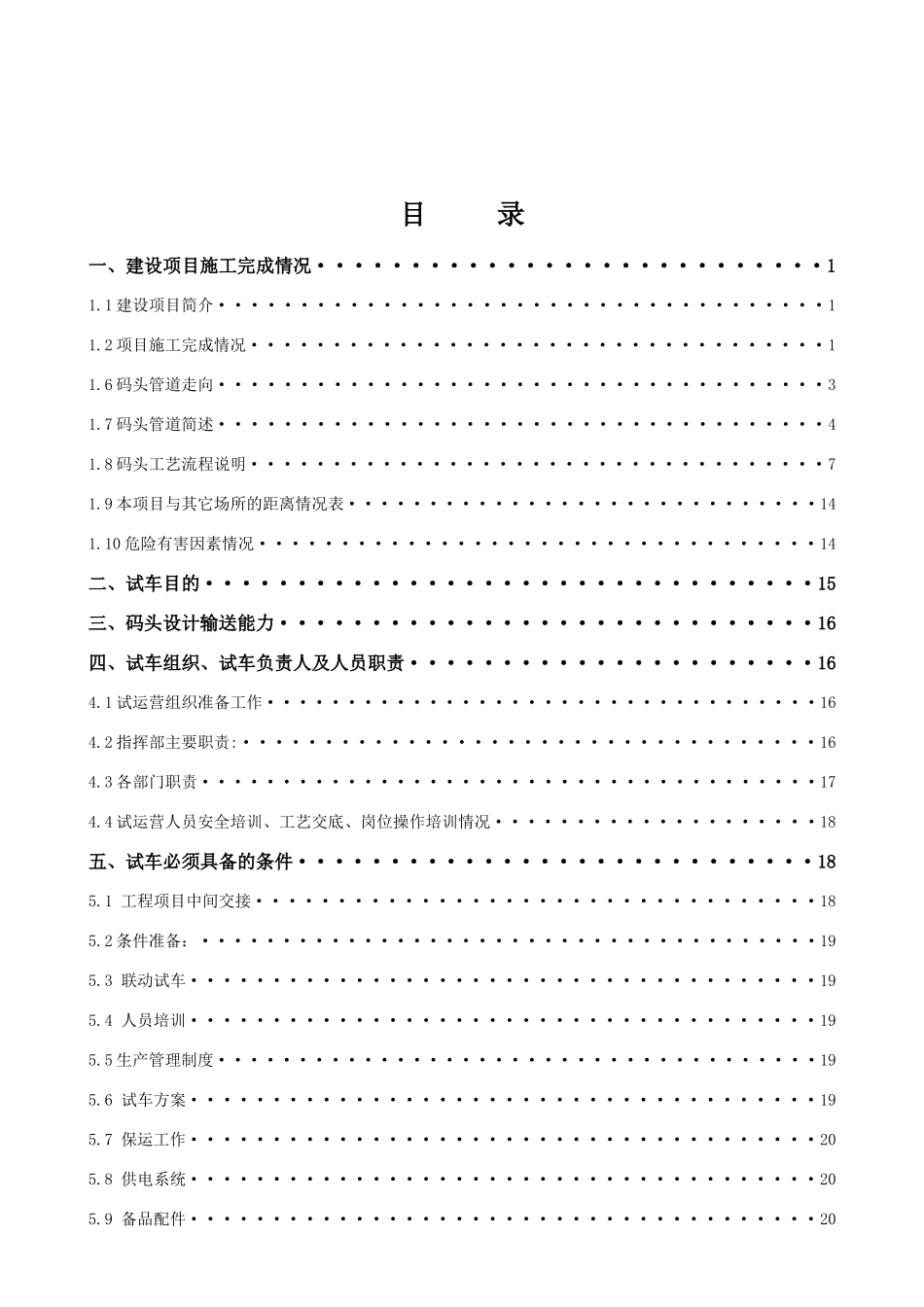

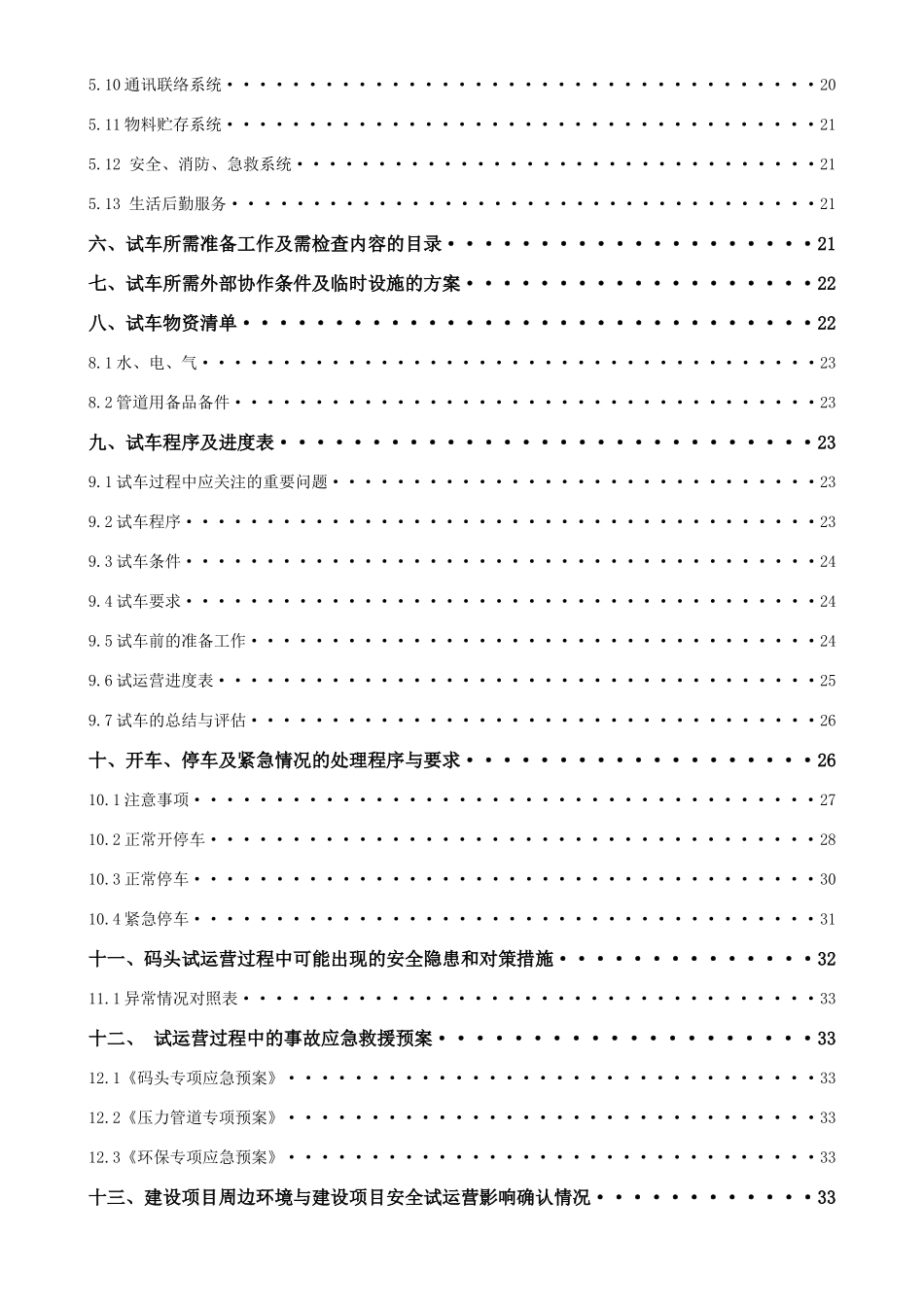

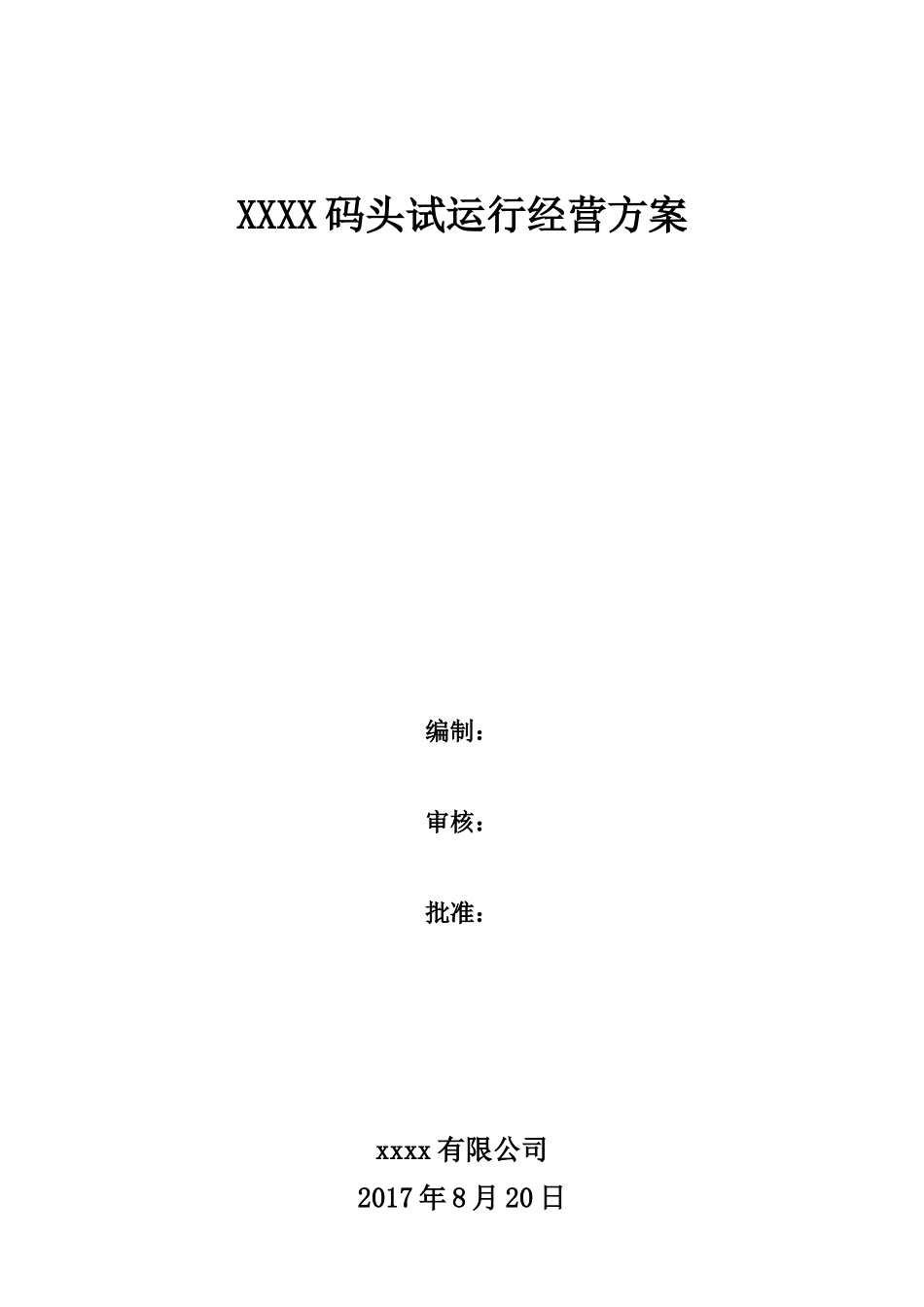

XXXX码头试运行经营方案编制:审核:批准:xxxx有限公司2017年8月20日目录一、建设项目施工完成情况···························11.1建设项目简介·····································11.2项目施工完成情况···································11.6码头管道走向·····································31.7码头管道简述·····································41.8码头工艺流程说明···································71.9本项目与其它场所的距离情况表·····························141.10危险有害因素情况··································14二、试车目的·································15三、码头设计输送能力·····························16四、试车组织、试车负责人及人员职责······················164.1试运营组织准备工作··································164.2指挥部主要职责:···································164.3各部门职责······································174.4试运营人员安全培训、工艺交底、岗位操作培训情况····················18五、试车必须具备的条件····························185.1工程项目中间交接··································185.2条件准备:······································195.3联动试车······································195.4人员培训······································195.5生产管理制度·····································195.6试车方案······································195.7保运工作······································205.8供电系统······································205.9备品配件······································205.10通讯联络系统····································205.11物料贮存系统····································215.12安全、消防、急救系统································215.13生活后勤服务····································21六、试车所需准备工作及需检查内容的目录····················21七、试车所需外部协作条件及临时设施的方案···················22八、试车物资清单·······························228.1水、电、气······································238.2管道用备品备件····································23九、试车程序及进度表·····························239.1试车过程中应关注的重要问题······························239.2试车程序·······································239.3试车条件····...
