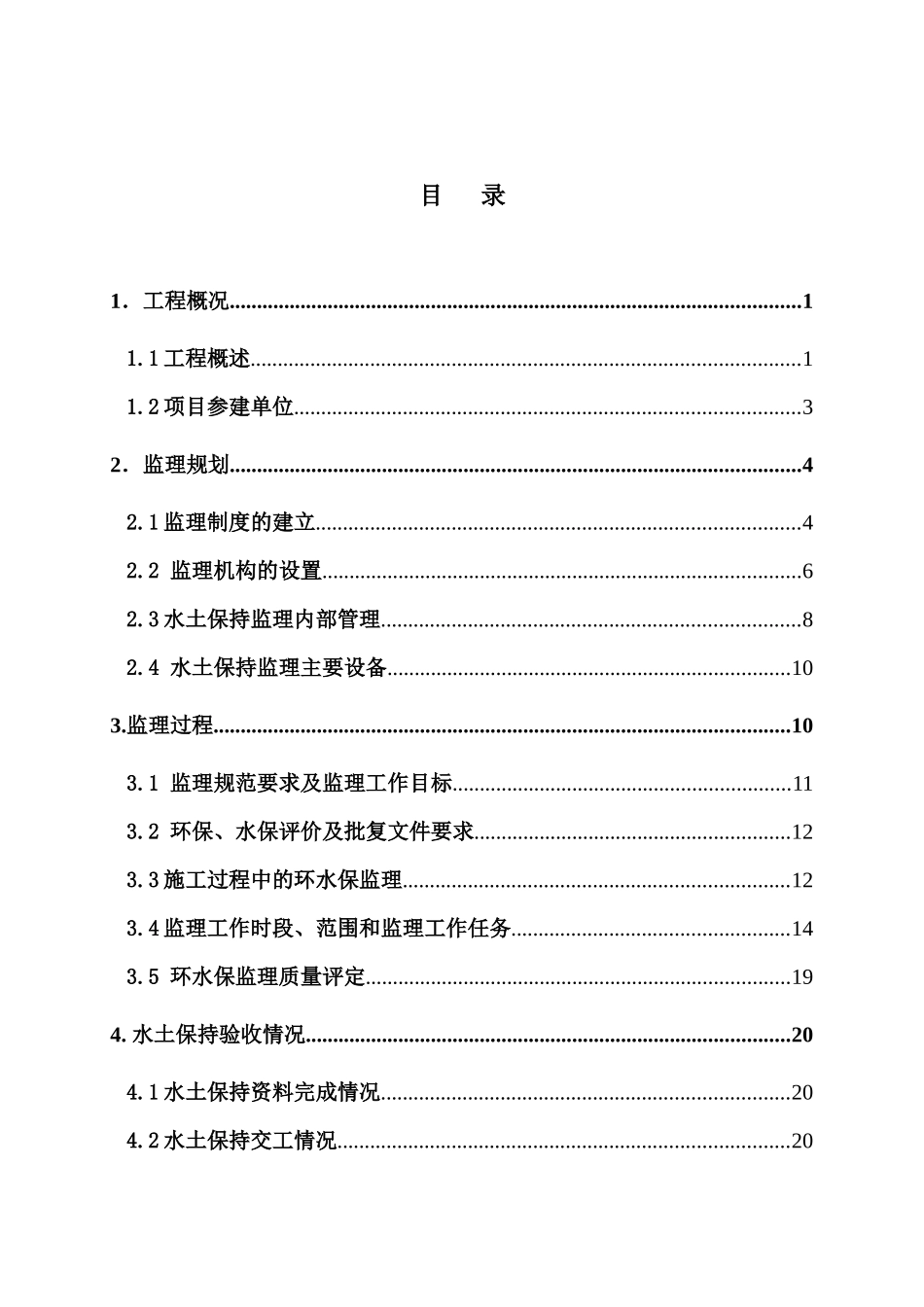

新建南广铁路NGJL-2合同段(IDK120+000~IDK252+657)水土保持监理工作总结四川铁科建设监理有限公司南广铁路NGJL-2项目部二○一三年十一月目录1.工程概况.........................................................................................................11.1工程概述.....................................................................................................11.2项目参建单位.............................................................................................32.监理规划.........................................................................................................42.1监理制度的建立.........................................................................................42.2监理机构的设置........................................................................................62.3水土保持监理内部管理.............................................................................82.4水土保持监理主要设备..........................................................................103.监理过程..........................................................................................................103.1监理规范要求及监理工作目标..............................................................113.2环保、水保评价及批复文件要求..........................................................123.3施工过程中的环水保监理.......................................................................123.4监理工作时段、范围和监理工作任务...................................................143.5环水保监理质量评定..............................................................................194.水土保持验收情况.........................................................................................204.1水土保持资料完成情况...........................................................................204.2水土保持交工情况...................................................................................205水土保持监理工作成效..................................................................................215.1水土保持监理的“五控制”工作...........................................................215.2水土保持监理的“两管理”工作...........................................................245.3水土保持监理的“一协调”工作...........................................................256.水土保持监理工作经验与建议.....................................................................266.1监理工作经验..........................................................................................266.2水土保持工作经验..................................................................................296.3建议..........................................................................................................30第1页共48页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第1页共48页四川铁科建设监理有限公司南广铁路NGJL-2标段水土保持监理工作总结1.工程概况1.1工程概述南广铁路设计走向沿珠江水道的西江—东江方向,从南宁出发,经黎塘、贵港、桂平、平南、藤县、梧州、云浮、肇庆、佛山等站,到达广州新客站,铁路全长574.734km。其中南宁至黎塘西段,南广铁路与柳南客专四线95.13km,黎塘至肇庆北,南广双线段401.607km,肇庆北至三眼桥,南广线与贵广线四线并行段61.397km,三眼桥至新广州站段利用在建贵广铁路16.6km。铁路设计时速达200km(预留提速条件),为双线电气化国家1级铁路。NGJL-2标管段起讫里程IDK120+000(=DK116+098)~IDK252+657(K212...
