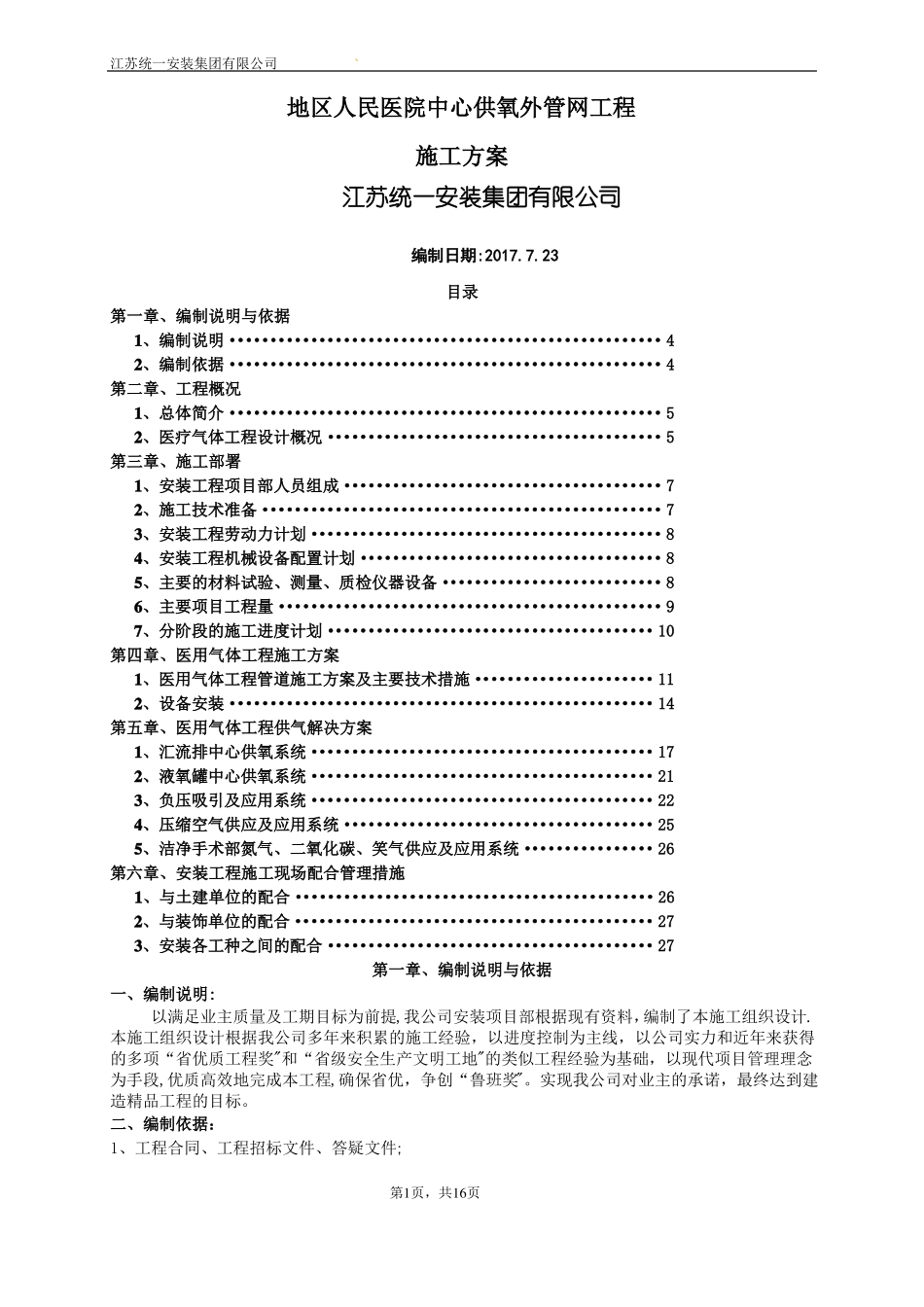

江苏统一安装集团有限公司`地区人民医院中心供氧外管网工程施工方案江苏统一安装集团有限公司编制日期:2017.7.23目录第一章、编制说明与依据1、编制说明·····················································42、编制依据·····················································4第二章、工程概况1、总体简介·····················································52、医疗气体工程设计概况·········································5第三章、施工部署1、安装工程项目部人员组成·······································72、施工技术准备·················································73、安装工程劳动力计划···········································84、安装工程机械设备配置计划·····································85、主要的材料试验、测量、质检仪器设备···························86、主要项目工程量···············································97、分阶段的施工进度计划········································10第四章、医用气体工程施工方案1、医用气体工程管道施工方案及主要技术措施······················112、设备安装····················································14第五章、医用气体工程供气解决方案1、汇流排中心供氧系统··········································172、液氧罐中心供氧系统··········································213、负压吸引及应用系统··········································224、压缩空气供应及应用系统······································255、洁净手术部氮气、二氧化碳、笑气供应及应用系统················26第六章、安装工程施工现场配合管理措施1、与土建单位的配合············································262、与装饰单位的配合············································273、安装各工种之间的配合········································27第一章、编制说明与依据一、编制说明:以满足业主质量及工期目标为前提,我公司安装项目部根据现有资料,编制了本施工组织设计.本施工组织设计根据我公司多年来积累的施工经验,以进度控制为主线,以公司实力和近年来获得的多项“省优质工程奖"和“省级安全生产文明工地"的类似工程经验为基础,以现代项目管理理念为手段,优质高效地完成本工程,确保省优,争创“鲁班奖"。实现我公司对业主的承诺,最终达到建造精品工程的目标。二、编制依据:1、工程合同、工程招标文件、答疑文件;第1页,共16页江苏统一安装集团有限公司`2、工程施工图纸:⑴、图纸名称及数量表:序号123456789101112131415序号12345一、总体简介:序号123456项目工程名称工程地址建设单位设计单位监理公司质量监督第2页,共16页图纸名称图纸编号气施1—01气施1—02~气施1-10气施1—02~气施1-10气施1-02~气施1—09气施1—10气施2—01气施2—02~气施2-10页数199811998116111备注1#楼设计说明及图例1#楼1#楼1#楼1#楼医用气体管道立管图2#...
