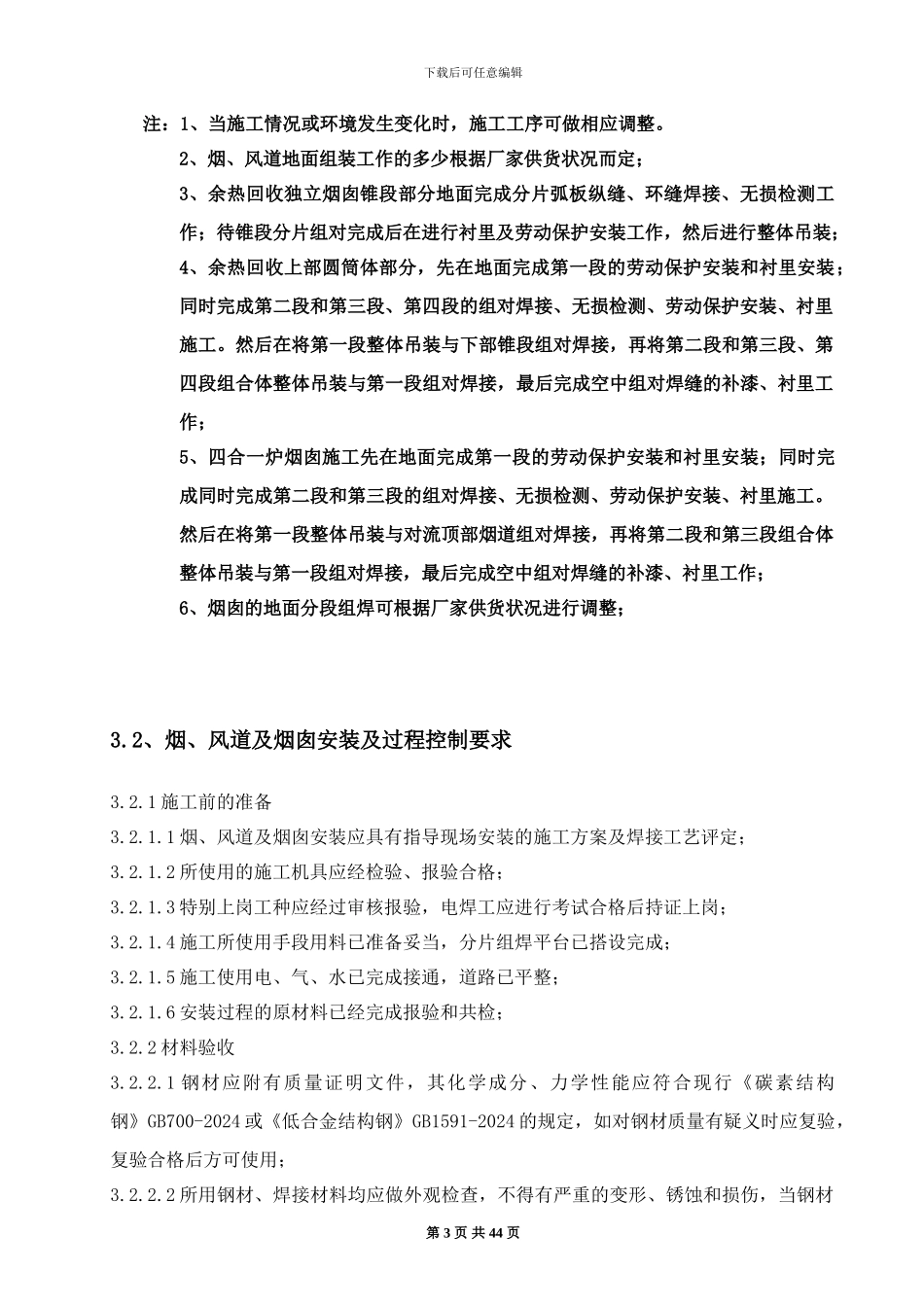

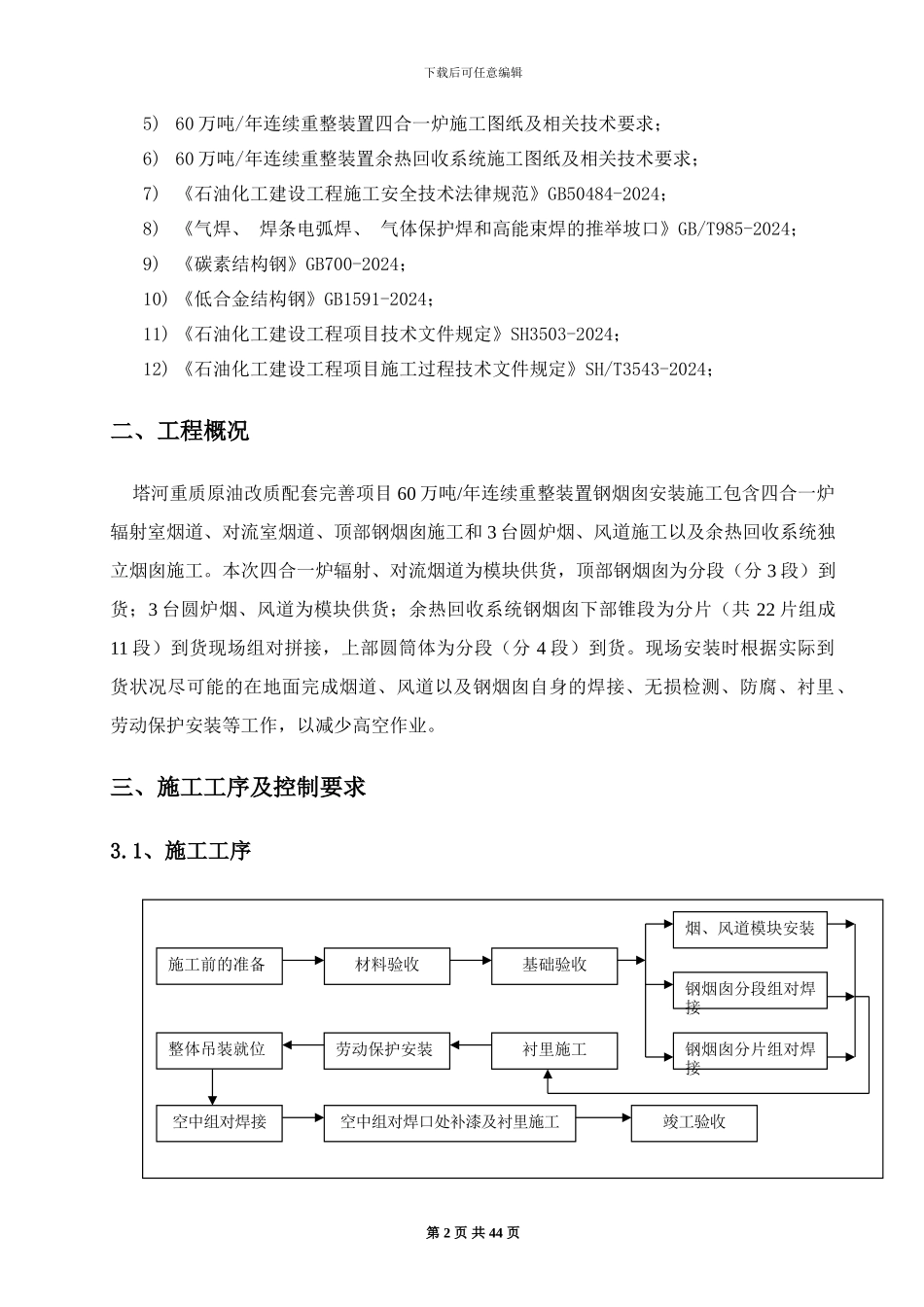

塔河重质原油改质配套完善项目 60 万吨/年连续重整装置 工业炉烟囱、烟风道安装施工方案一、编制依据..................................................................................................2二、工程概况..................................................................................................2三、施工工序及控制要求..............................................................................33.1、施工工序.................................................................................................33.2、烟、风道及烟囱安装及过程控制要求.................................................4四、质量控制要求........................................................................................114.1、质量控制体系.............................................................................................114.2、质量通病及预防措施.................................................................................114.3、烟囱安装施工质量控制点.........................................................................13五、劳动力安排............................................................................................13六、施工机具安排........................................................................................13七、 HSE 保证措施......................................................................................147.1、项目 HSE 管理方针....................................................................................147.2、项目 HSE 管理目标....................................................................................147.3 、项目 HSE 管理组织机构...........................................................................157.4、现场施工 HSE 管理规定............................................................................15一、编制依据1) 《石油化工管式炉钢结构工程及部件安装技术条件》SH3086-1998;2) 《工业炉烟、风道及其附属设备工程技术条件》72B111-1997;3) 《钢结构工程施工质量验收法律规范》GB50205-20014) 60 万吨/年连续重整装置...
