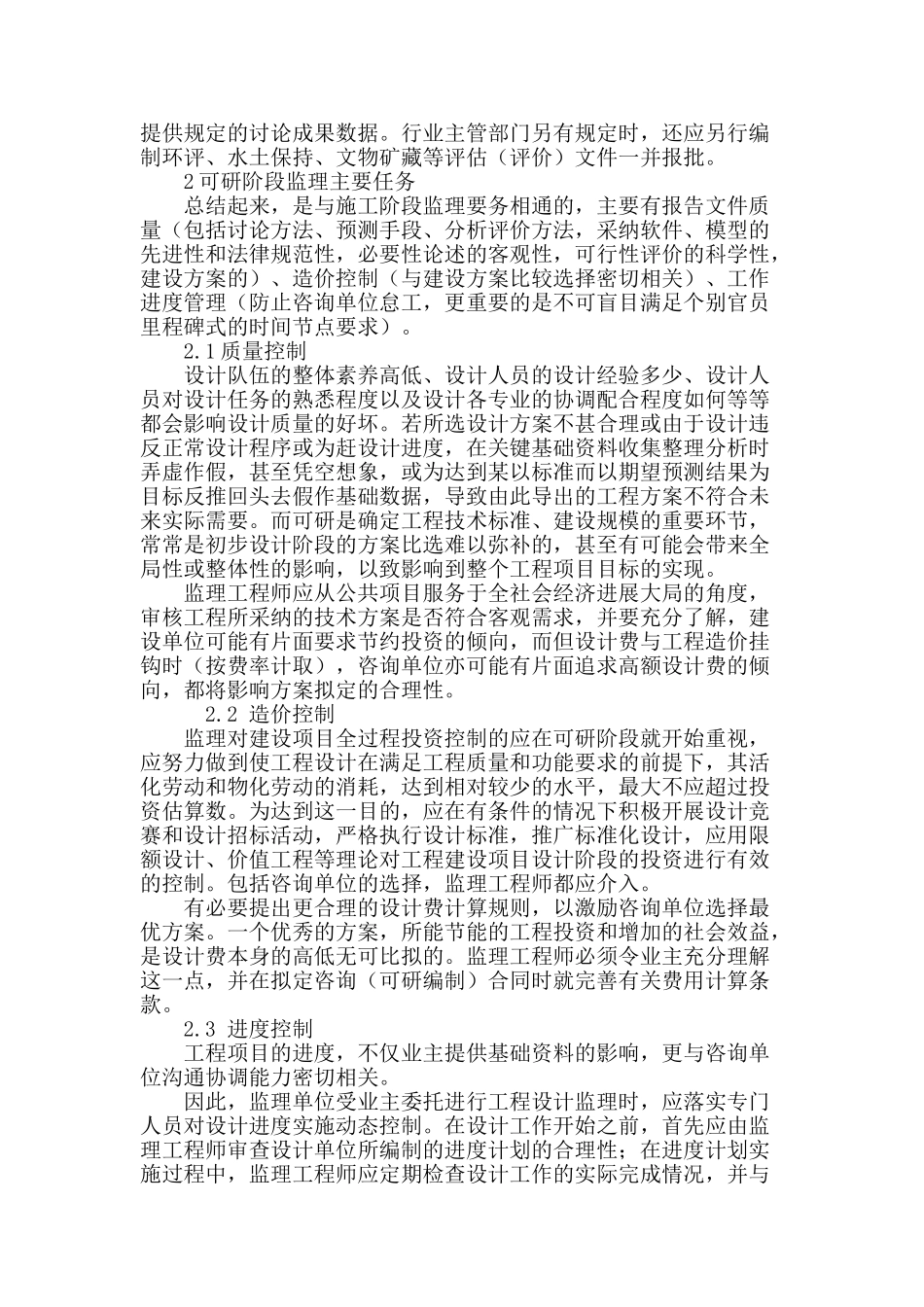

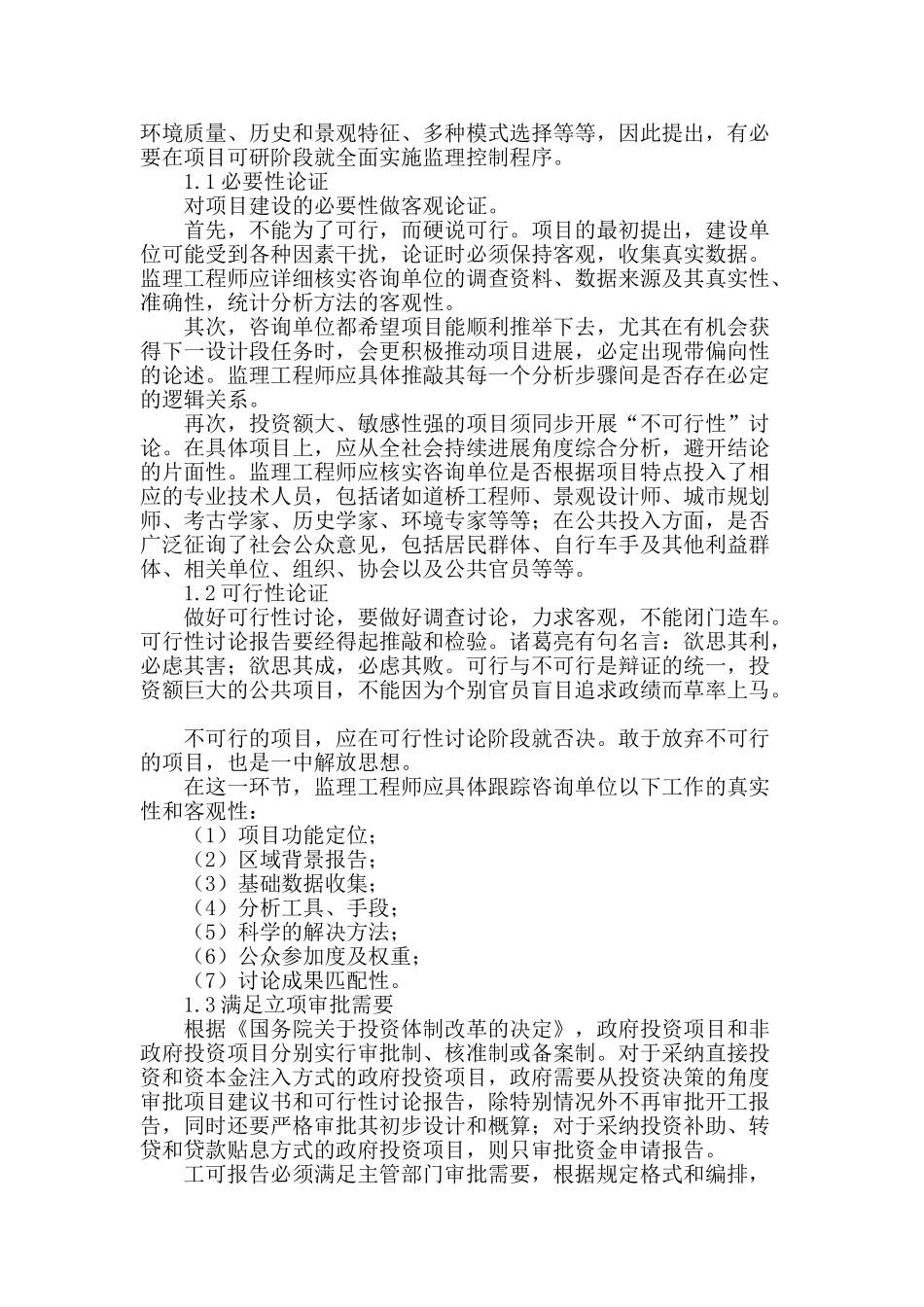

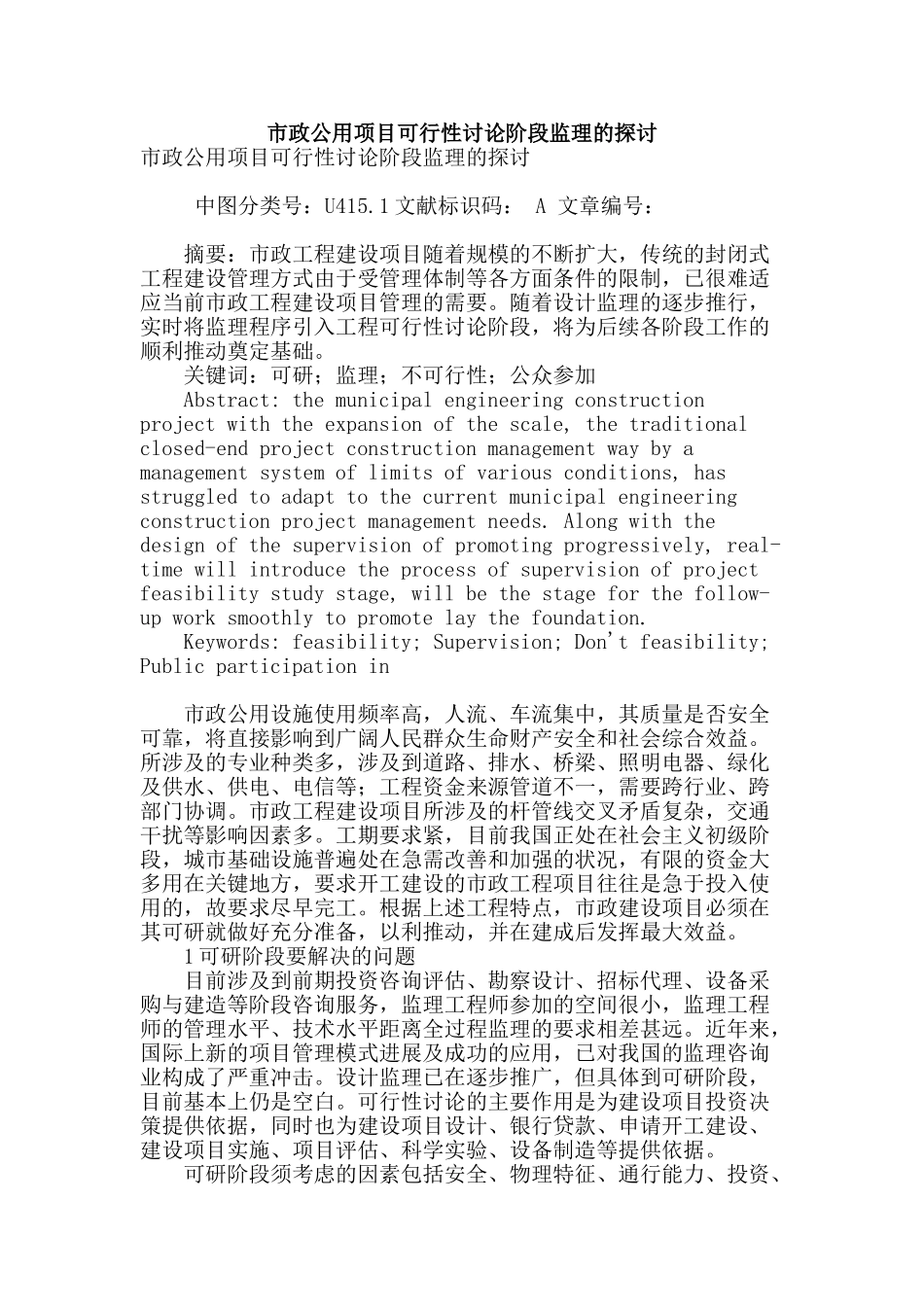

市政公用项目可行性讨论阶段监理的探讨市政公用项目可行性讨论阶段监理的探讨 中图分类号:U415.1 文献标识码: A 文章编号: 摘要:市政工程建设项目随着规模的不断扩大,传统的封闭式工程建设管理方式由于受管理体制等各方面条件的限制,已很难适应当前市政工程建设项目管理的需要。随着设计监理的逐步推行,实时将监理程序引入工程可行性讨论阶段,将为后续各阶段工作的顺利推动奠定基础。 关键词:可研;监理;不可行性;公众参加 Abstract: the municipal engineering construction project with the expansion of the scale, the traditional closed-end project construction management way by a management system of limits of various conditions, has struggled to adapt to the current municipal engineering construction project management needs. Along with the design of the supervision of promoting progressively, real-time will introduce the process of supervision of project feasibility study stage, will be the stage for the follow-up work smoothly to promote lay the foundation. Keywords: feasibility; Supervision; Don't feasibility; Public participation in 市政公用设施使用频率高,人流、车流集中,其质量是否安全可靠,将直接影响到广阔人民群众生命财产安全和社会综合效益。所涉及的专业种类多,涉及到道路、排水、桥梁、照明电器、绿化及供水、供电、电信等;工程资金来源管道不一,需要跨行业、跨部门协调。市政工程建设项目所涉及的杆管线交叉矛盾复杂,交通干扰等影响因素多。工期要求紧,目前我国正处在社会主义初级阶段,城市基础设施普遍处在急需改善和加强的状况,有限的资金大多用在关键地方,要求开工建设的市政工程项目往往是急于投入使用的,故要求尽早完工。根据上述工程特点,市政建设项目必须在其可研就做好充分准备,以利推动,并在建成后发挥最大效益。 1 可研阶段要解决的问题 目前涉及到前期投资咨询评估、勘察设计、招标代理、设备采购与建造等阶段咨询服务,监理工程师参加的空间很小,监理工程师的管理水平、技术水平距离全过程监理的要求相差甚远。近年来,国际上新的项目管理模式进展及成功的应用,已对我国的监理咨询业构成了严重冲击。设计监理已在逐步推广,但具...
