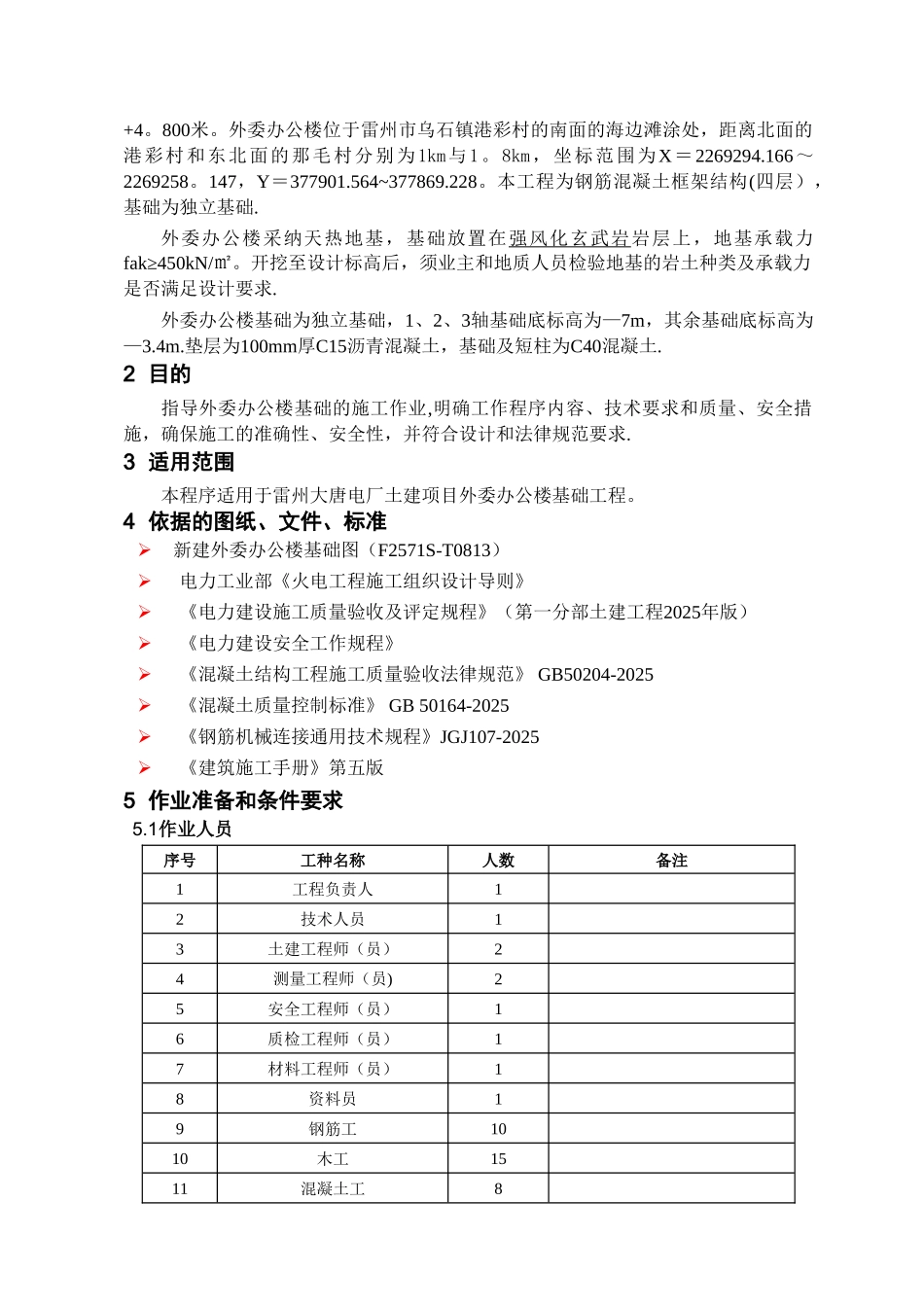

A初版实施REV版次签名日期签名日期签名日期MODI。修改STATUS状态编写 AUTH。审核 CHK’D BY批准 APP’D BY文件号DOCUMENT NO.CEPC/LZXM/GZCS—001办公楼基础工程工作程序基础工程版权所有COPYRIGHT CEPC/GZCS 2025 Page 1 of 16目 录1 施工概况.........................................................................................22 目的................................................................................................33 适用范围.........................................................................................34 依据的图纸、文件、标准..............................................................35 作业准备和条件要求.....................................................................35。1 作业人员..........................................................................................35。2 作业机具..........................................................................................45。3 施工用电、水布置...........................................................................45。4 水平、垂直运输设备及布置.............................................................56 施工工序关键的质量控制点..........................................................56。1 控制点的设置和要求........................................................................57 作业程序内容.................................................................................57.1施工程序..........................................................................................57。2 土石方开挖(如需回填).....................................................................57.3边坡防护、基坑清理与基坑排水......................................................67。4 垫层混凝土......................................................................................67.5钢筋工程..........................................................................................67.6钢筋施工注意事项...........................................................................87.7模板工程...........
