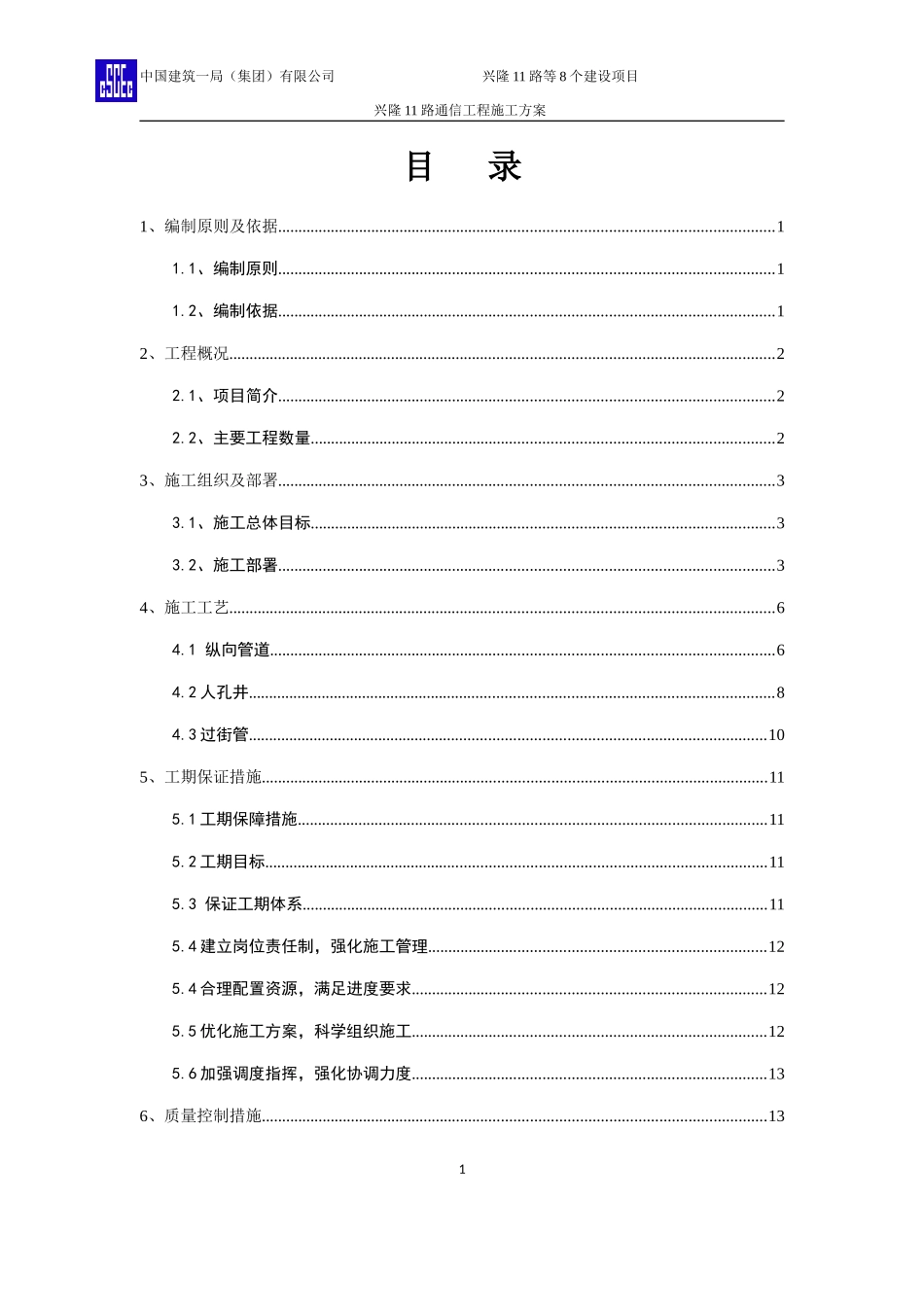

兴隆11路等8个建设项目兴隆11路通信工程施工方案编制:审核:审批:中国建筑一局(集团)有限公司兴隆11路等8个建设项目二〇一六年八月1中国建筑一局(集团)有限公司兴隆11路等8个建设项目兴隆11路通信工程施工方案目录1、编制原则及依据.........................................................................................................................11.1、编制原则.........................................................................................................................11.2、编制依据.........................................................................................................................12、工程概况.....................................................................................................................................22.1、项目简介.........................................................................................................................22.2、主要工程数量.................................................................................................................23、施工组织及部署.........................................................................................................................33.1、施工总体目标.................................................................................................................33.2、施工部署.........................................................................................................................34、施工工艺.....................................................................................................................................64.1纵向管道...........................................................................................................................64.2人孔井................................................................................................................................84.3过街管..............................................................................................................................105、工期保证措施...........................................................................................................................115.1工期保障措施..................................................................................................................115.2工期目标..........................................................................................................................115.3保证工期体系.................................................................................................................115.4建立岗位责任制,强化施工管理..................................................................................125.4合理配置资源,满足进度要求......................................................................................125.5优化施工方案,科学组织施工......................................................................................125.6加强调度指挥,强化协调力度......................................................................................136、质量控制措施...........................................................................................................................132中国建筑一局(集团)有限公司兴隆11路等8个建设项目兴隆11路通信工程施工方案6.1质量保证体系及管理程序..............................................................................................136.2质量保...
