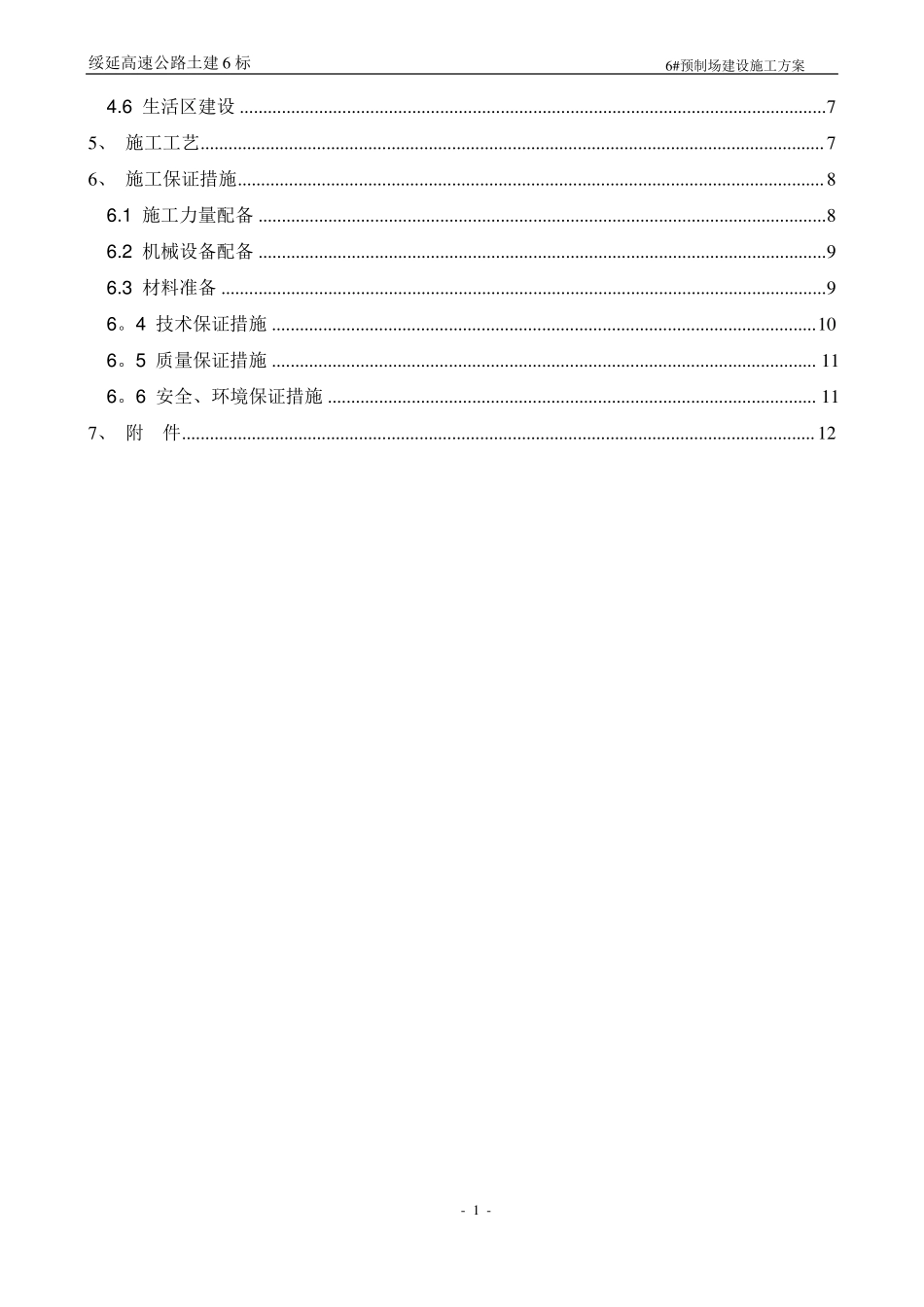

陕西省绥德至延川高速公路(含清涧至子长高速连接线)6#预制场建设施工方案编制人:复核人:审核人:中铁北京工程局集团第一工程有限公司绥延高速公路土建六经理部二○一八年三月目录1、编制依据......................................................................................................................................02、编制范围、原则..........................................................................................................................03、工程概况......................................................................................................................................04、施工方案......................................................................................................................................14。1工期计划...............................................................................................................................14。2总体方案...............................................................................................................................14.3梁场建设规划..........................................................................................................................14.4施工部署及计划安排..............................................................................................................34.4。1主要功能区....................................................................................................................34.4.2预制梁台座.......................................................................................................................44。5存梁枕...................................................................................................................................64.5.3梁底支座钢板预留坑.......................................................................................................74.5。4场内运输通道................................................................................................................7绥延高速公路土建6标6#预制场建设施工方案4.6生活区建设..............................................................................................................................75、施工工艺......................................................................................................................................76、施工保证措施..............................................................................................................................86.1施工力量配备..........................................................................................................................86.2机械设备配备..........................................................................................................................96.3材料准备..................................................................................................................................96。4技术保证措施.....................................................................................................................106。5质量保证措施.....................................................................................................................116。6安全、环境保证措施.........................................................................................................117、附件...........................................................................
