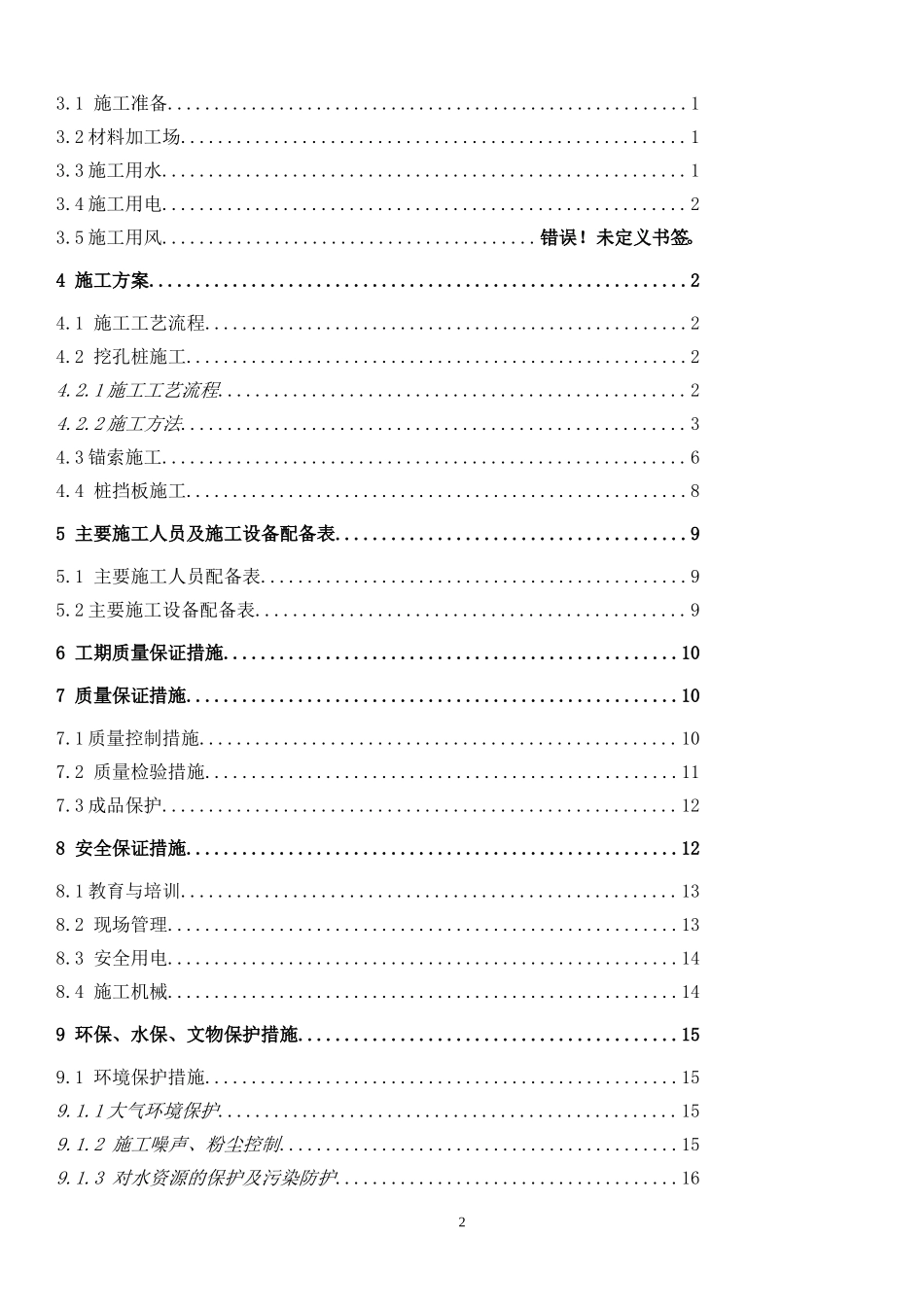

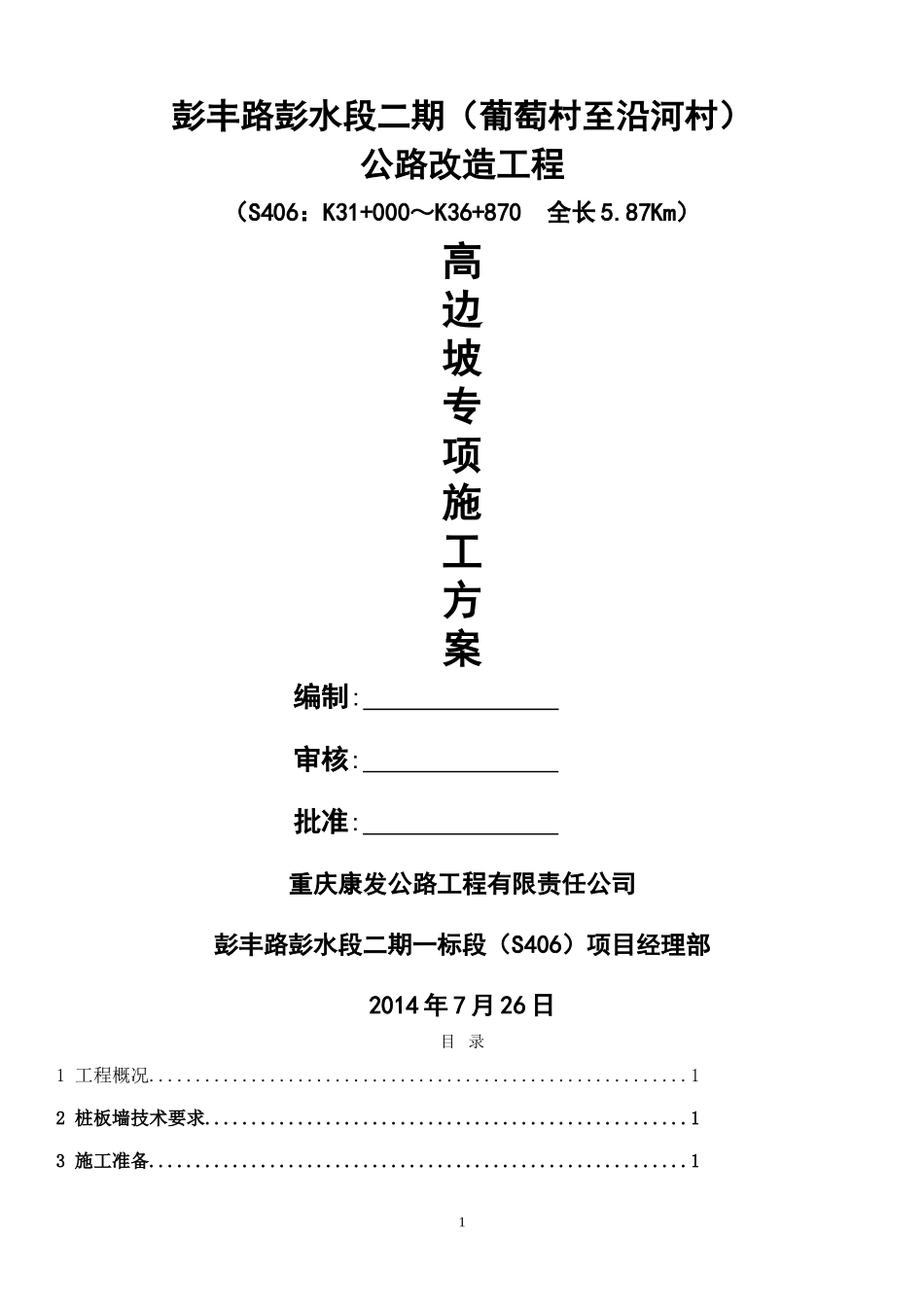

彭丰路彭水段二期(葡萄村至沿河村)公路改造工程(S406:K31+000~K36+870全长5.87Km)高边坡专项施工方案编制:审核:批准:重庆康发公路工程有限责任公司彭丰路彭水段二期一标段(S406)项目经理部2014年7月26日目录1工程概况..........................................................12桩板墙技术要求....................................................13施工准备..........................................................113.1施工准备........................................................13.2材料加工场......................................................13.3施工用水........................................................13.4施工用电........................................................23.5施工用风........................................错误!未定义书签。4施工方案..........................................................24.1施工工艺流程....................................................24.2挖孔桩施工......................................................24.2.1施工工艺流程..................................................24.2.2施工方法......................................................34.3锚索施工........................................................64.4桩挡板施工......................................................85主要施工人员及施工设备配备表......................................95.1主要施工人员配备表..............................................95.2主要施工设备配备表..............................................96工期质量保证措施.................................................107质量保证措施.....................................................107.1质量控制措施...................................................107.2质量检验措施...................................................117.3成品保护.......................................................128安全保证措施.....................................................128.1教育与培训.....................................................138.2现场管理.......................................................138.3安全用电.......................................................148.4施工机械.......................................................149环保、水保、文物保护措施.........................................159.1环境保护措施...................................................159.1.1大气环境保护.................................................159.1.2施工噪声、粉尘控制...........................................159.1.3对水资源的保护及污染防护.....................................1629.2水土保持措施...................................................169.3文物保护措施...................................................163桩板墙专项施工方案1工程概况本工程位于s406彭丰路彭水段二期K35+580-K35-690路基左侧在边坡开挖完过程中,因为当地气候原因,可能产生了滑移。因此设计防护形式为桩板墙。设计方案,此段设计抗滑桩共计23根,其中3到12号桩径为:2.4m×3.4m抗滑桩;其余桩径1.5m×2m,为防止桩间土挤出桩间设挡土墙。2桩板墙技术要求1)现场的设备摆放、材料的堆放等均要做到整齐、平顺。2)桩板墙采用跳桩开挖基坑,护壁及时跟进。桩身混凝土及时连续不间断浇灌,避免形成相对软弱截面。3)须拆除护壁的桩身部分,桩身与护壁间须采取隔离措施(如铺设宝丽板),以利拆除及使桩身平整美观。4)开挖桩孔如遇地下水,不能持续强抽水,及时会同设计等有关单位研究处理措施,以免造成塌孔。5)桩板墙灌注桩身混凝土前,要预埋锚索孔口定位管贯穿桩身。开挖桩前土方时,分层开挖至锚索施工工作面,先施工锚索,按设计要求加力锁定后...
