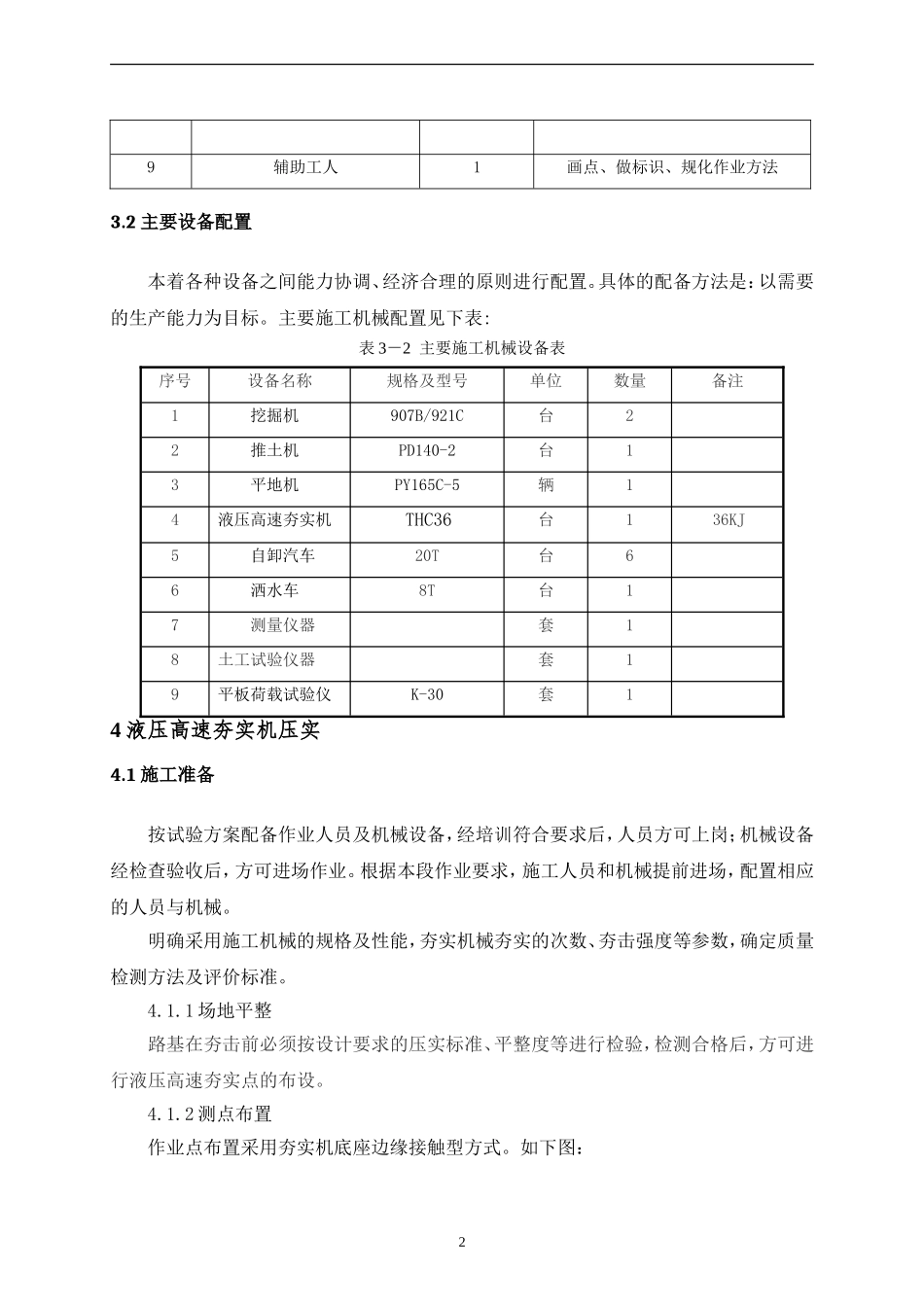

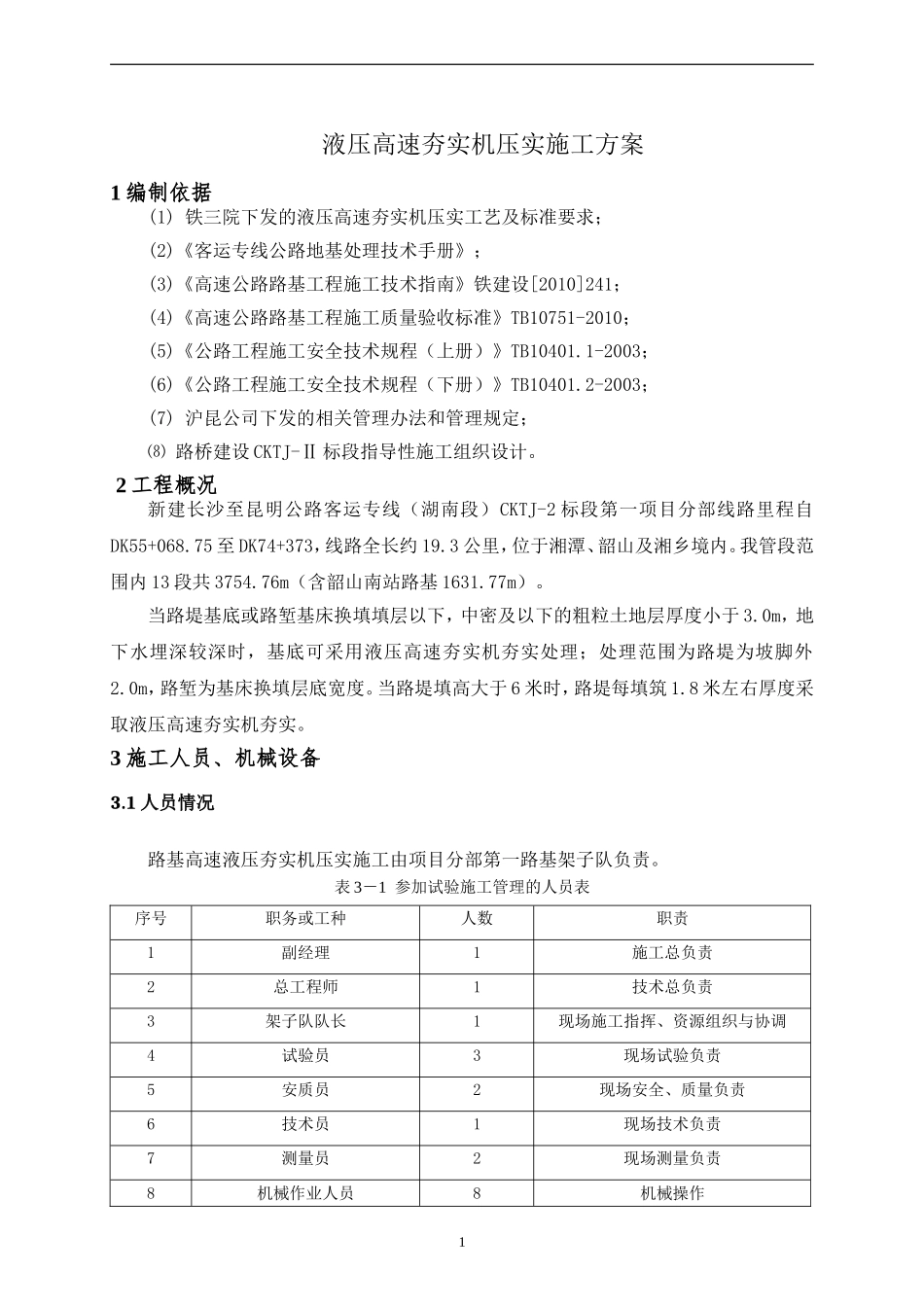

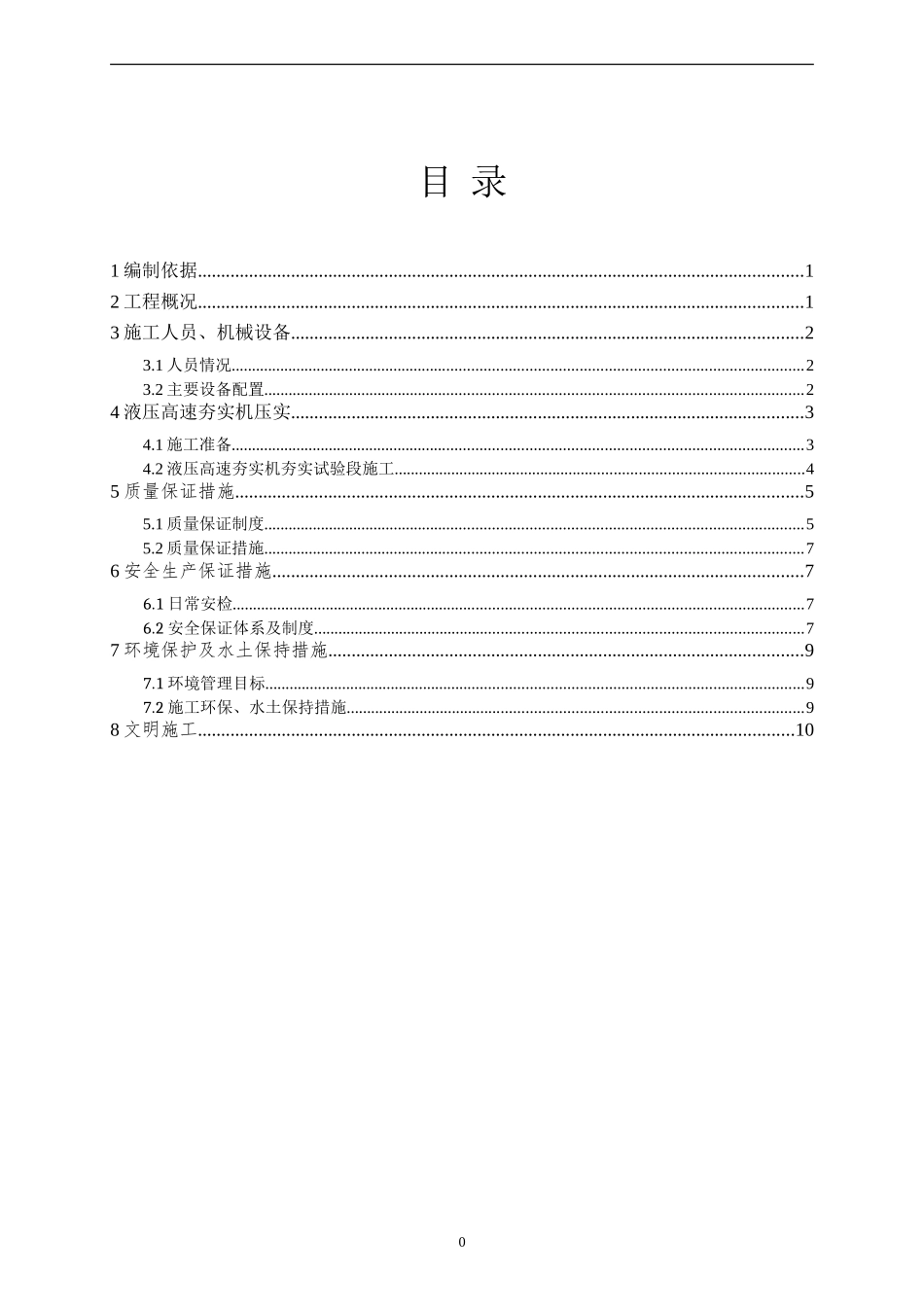

目录1编制依据..................................................................................................................................12工程概况..................................................................................................................................13施工人员、机械设备..............................................................................................................23.1人员情况...........................................................................................................................................23.2主要设备配置...................................................................................................................................24液压高速夯实机压实..............................................................................................................34.1施工准备...........................................................................................................................................34.2液压高速夯实机夯实试验段施工....................................................................................................45质量保证措施..........................................................................................................................55.1质量保证制度...................................................................................................................................55.2质量保证措施...................................................................................................................................76安全生产保证措施..................................................................................................................76.1日常安检...........................................................................................................................................76.2安全保证体系及制度.......................................................................................................................77环境保护及水土保持措施......................................................................................................97.1环境管理目标...................................................................................................................................97.2施工环保、水土保持措施...............................................................................................................98文明施工................................................................................................................................100液压高速夯实机压实施工方案1编制依据(1)铁三院下发的液压高速夯实机压实工艺及标准要求;(2)《客运专线公路地基处理技术手册》;(3)《高速公路路基工程施工技术指南》铁建设[2010]241;(4)《高速公路路基工程施工质量验收标准》TB10751-2010;(5)《公路工程施工安全技术规程(上册)》TB10401.1-2003;(6)《公路工程施工安全技术规程(下册)》TB10401.2-2003;(7)沪昆公司下发的相关管理办法和管理规定;⑻路桥建设CKTJ-Ⅱ标段指导性施工组织设计。2工程概况新建长沙至昆明公路客运专线(湖南段)CKTJ-2标段第一项目分部线路里程自DK55+068.75至DK74+373,线路全长约19.3公里,位于湘潭、韶山及湘乡境内。我管段范围内13段共3754.76m(含韶山南站路基1631.77m)。当路堤基底或路堑基床换填填层以下,中密及以下的粗粒土地层厚度小于3.0m,地下水埋深较深时,基底可采用液压高速夯实机夯实处理;处理范围为路堤为坡脚外2.0m,路堑为基床换填层底宽度。当路堤填...
