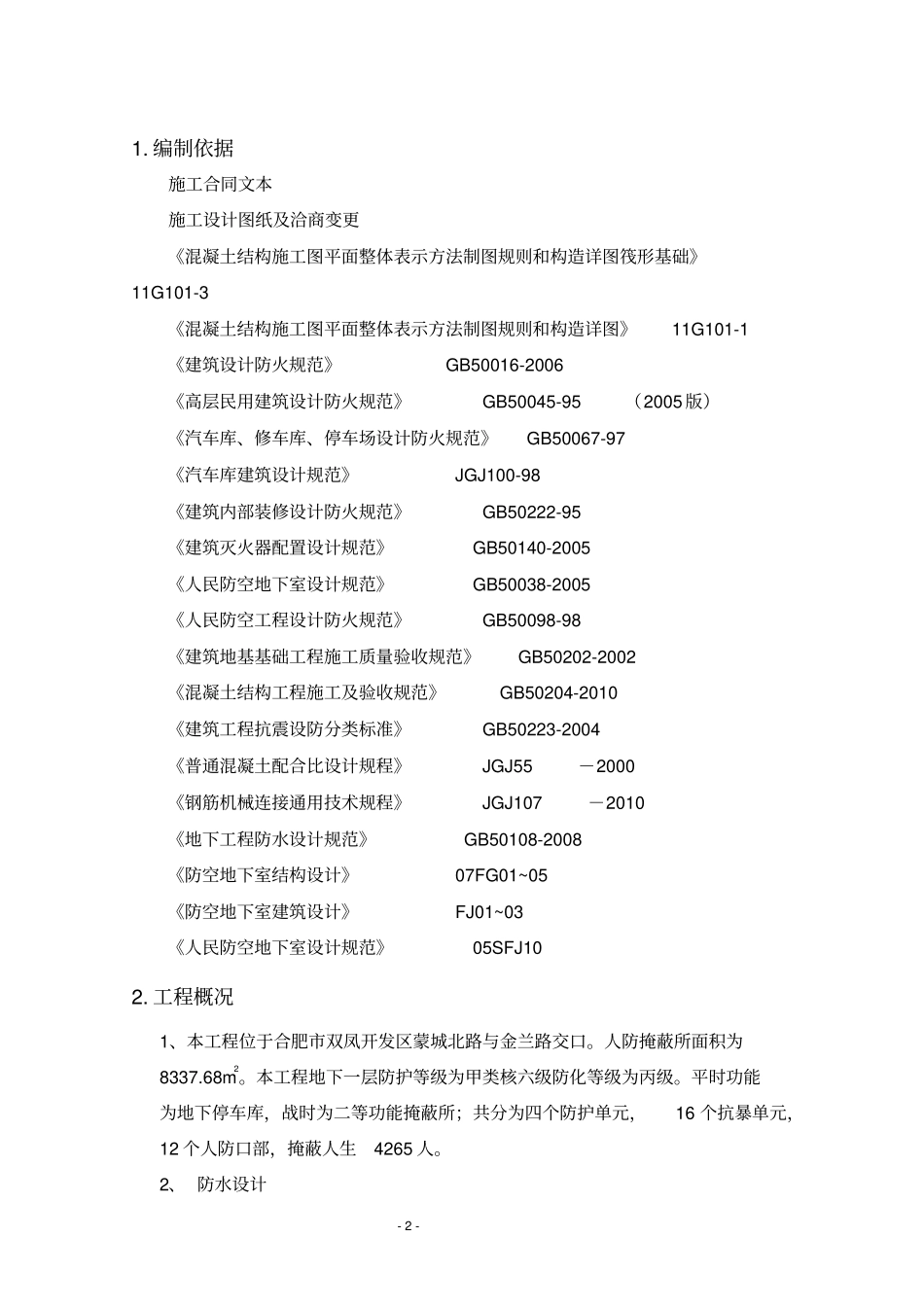

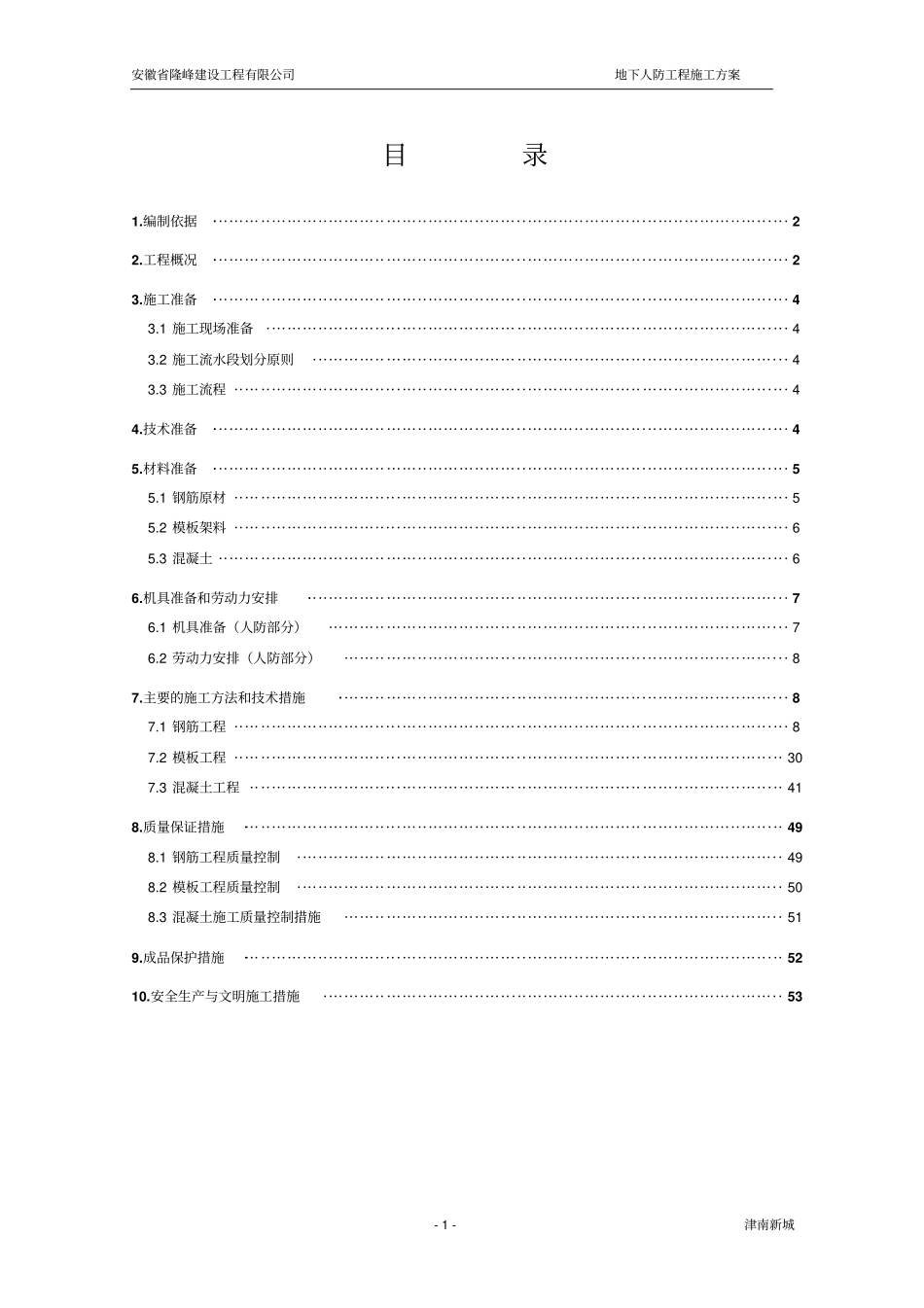

安徽省隆峰建设工程有限公司地下人防工程施工方案-1-津南新城目录1.编制依据··············································································································22.工程概况··············································································································23.施工准备··············································································································43.1施工现场准备····································································································43.2施工流水段划分原则···························································································43.3施工流程··········································································································44.技术准备··············································································································45.材料准备··············································································································55.1钢筋原材··········································································································55.2模板架料··········································································································65.3混凝土·············································································································66.机具准备和劳动力安排····························································································76.1机具准备(人防部分)························································································76.2劳动力安排(人防部分)·····················································································87.主要的施工方法和技术措施··················································································...
