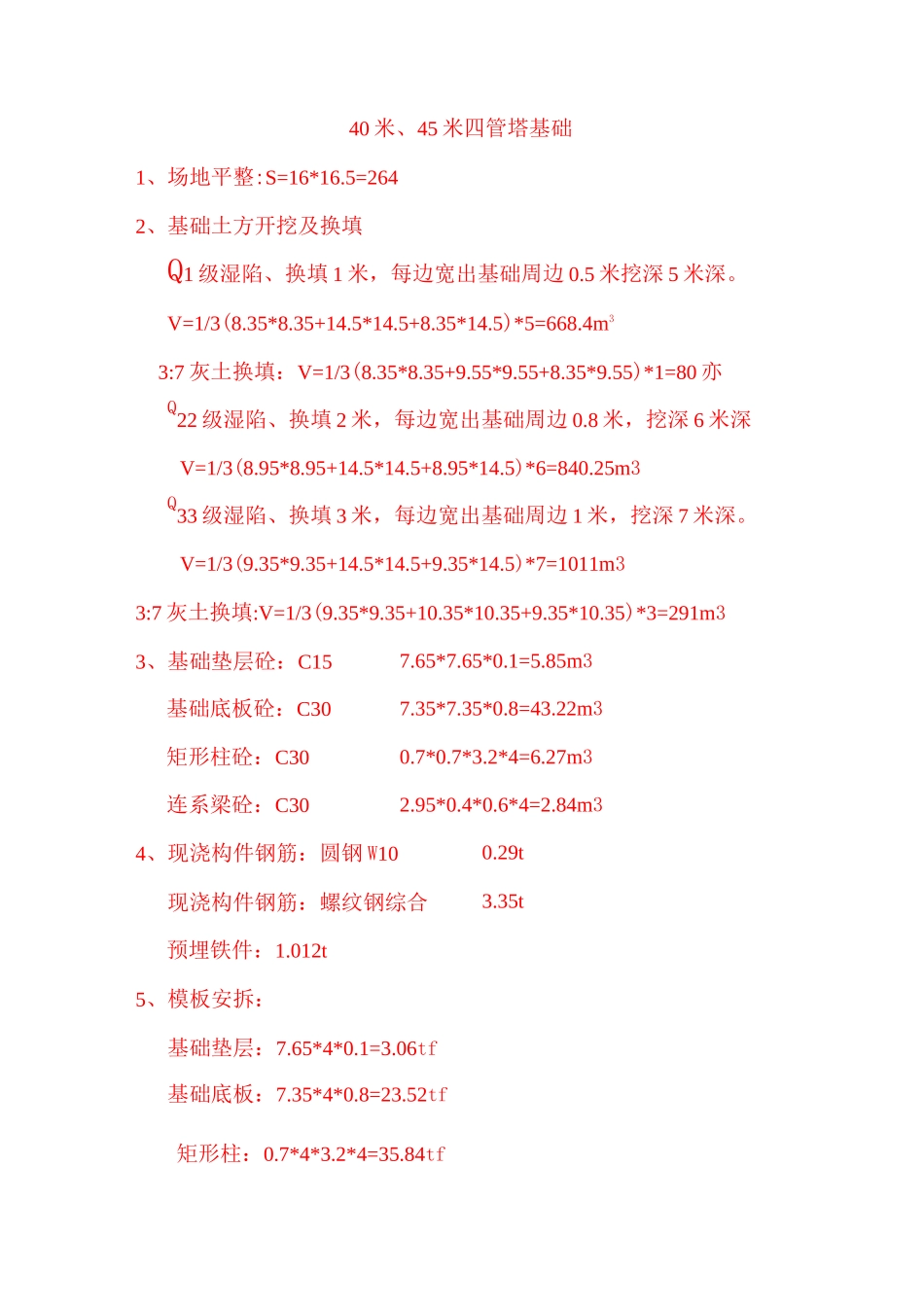

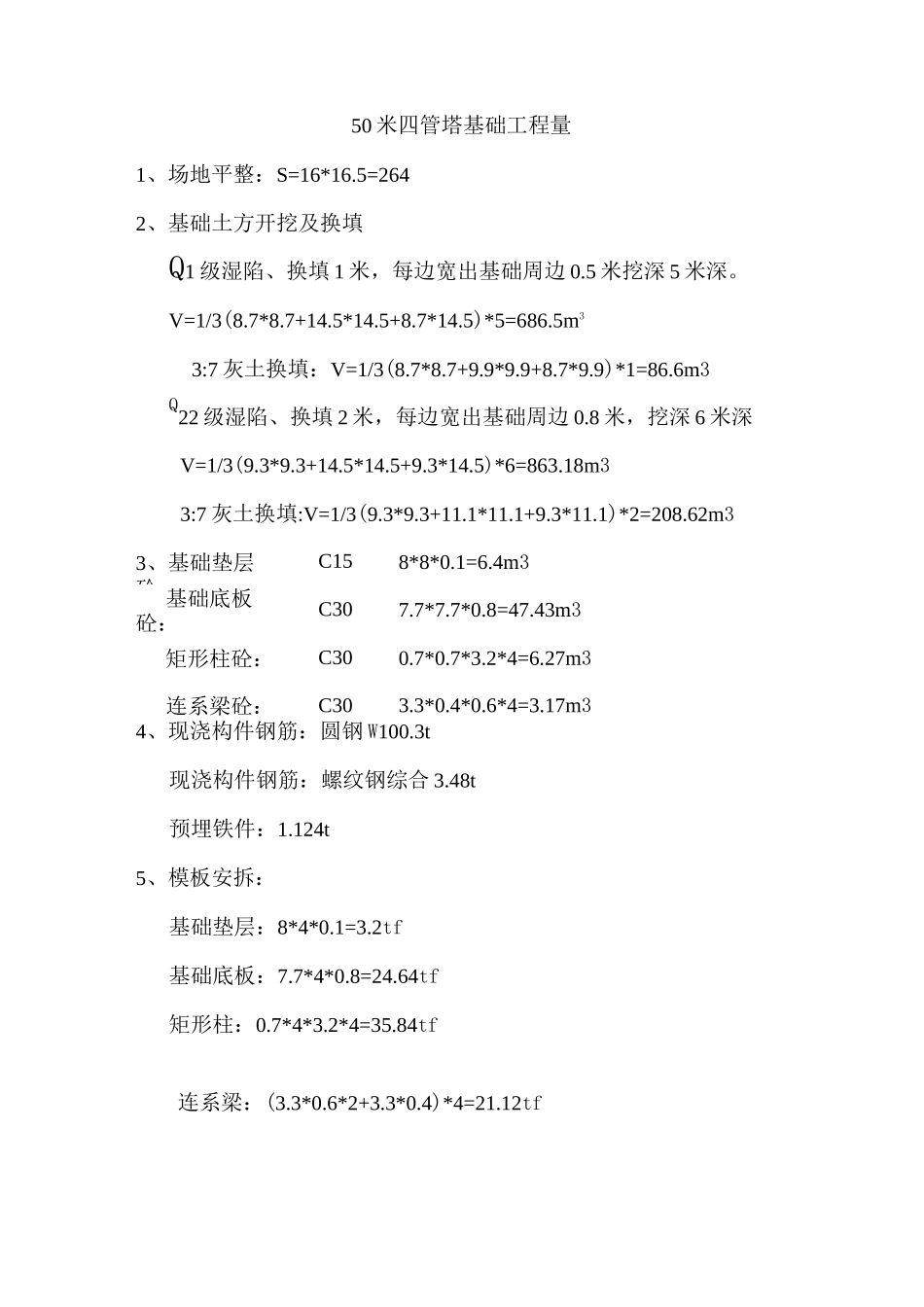

连系梁:(3.3*0.6*2+3.3*0.4)*4=21.12tf50米四管塔基础工程量1、场地平整:S=16*16.5=2642、基础土方开挖及换填Q1级湿陷、换填1米,每边宽出基础周边0.5米挖深5米深。V=1/3(8.7*8.7+14.5*14.5+8.7*14.5)*5=686.5m33:7灰土换填:V=1/3(8.7*8.7+9.9*9.9+8.7*9.9)*1=86.6m3Q22级湿陷、换填2米,每边宽出基础周边0.8米,挖深6米深V=1/3(9.3*9.3+14.5*14.5+9.3*14.5)*6=863.18m33:7灰土换填:V=1/3(9.3*9.3+11.1*11.1+9.3*11.1)*2=208.62m33、基础垫层砼:C158*8*0.1=6.4m3基础底板砼:C307.7*7.7*0.8=47.43m3矩形柱砼:C300.7*0.7*3.2*4=6.27m3连系梁砼:C303.3*0.4*0.6*4=3.17m34、现浇构件钢筋:圆钢W100.3t现浇构件钢筋:螺纹钢综合3.48t预埋铁件:1.124t5、模板安拆:基础垫层:8*4*0.1=3.2tf基础底板:7.7*4*0.8=24.64tf矩形柱:0.7*4*3.2*4=35.84tf6、连系梁下底、侧面灰渣回填(300厚)V=5.5*5.5*0.3=9.07m37、硬化面下换填(300厚)3:7灰土:V=(10.7*10.7-0.7*0.7*4)*0.3=33.76m3水泥砂浆地面:S=10.7*10.7-0.7*0.7*4=112.538、土方回填:Q1级湿陷、换填1米,每边宽出基础周边0.5米,挖深5米深,围墙内场坪高出自然地面0.5米。V=686.8-86.6-63.27-9.07-33.76+0.5*264=626.13m3Q22级湿陷、换填2米,每边宽出基础周边0.8米,挖深6米深。围墙内场坪高出自然地面0.5米。V=863.18-208.62-63.27-9.07-33.76+0.5*264=680.46m39、接地装置安装接地扁钢:-40mm*4mm74米接地角钢:50mm*5mm24米矩形柱:0.7*4*3.2*4=35.84tf40米、45米四管塔基础1、场地平整:S=16*16.5=2642、基础土方开挖及换填Q1级湿陷、换填1米,每边宽出基础周边0.5米挖深5米深。V=1/3(8.35*8.35+14.5*14.5+8.35*14.5)*5=668.4m33:7灰土换填:V=1/3(8.35*8.35+9.55*9.55+8.35*9.55)*1=80亦Q22级湿陷、换填2米,每边宽出基础周边0.8米,挖深6米深V=1/3(8.95*8.95+14.5*14.5+8.95*14.5)*6=840.25m3Q33级湿陷、换填3米,每边宽出基础周边1米,挖深7米深。V=1/3(9.35*9.35+14.5*14.5+9.35*14.5)*7=1011m33:7灰土换填:V=1/3(9.35*9.35+10.35*10.35+9.35*10.35)*3=291m33、基础垫层砼:C157.65*7.65*0.1=5.85m3基础底板砼:C307.35*7.35*0.8=43.22m3矩形柱砼:C300.7*0.7*3.2*4=6.27m3连系梁砼:C302.95*0.4*0.6*4=2.84m34、现浇构件钢筋:圆钢W100.29t现浇构件钢筋:螺纹钢综合3.35t预埋铁件:1.012t5、模板安拆:基础垫层:7.65*4*0.1=3.06tf基础底板:7.35*4*0.8=23.52tf连系梁:(2.95*0.6*2+2.95*0.4)*4=18.886、连系梁下底、侧面灰渣回填(300厚)V=5.15*5.15*0.3=7.96m37、硬化面下换填(300厚)3:7灰土:V=(10.35*10.35-0.7*0.7*4)*0.3=31.548m3水泥砂浆地面:S=10.35*10.35-0.7*0.7*4=105.16tf8、土方回填:Q1级湿陷、换填1米,每边宽出基础周边0.5米,挖深5米深。围墙内场坪高出自然地面0.5米。V=668.4-80.2-58.23-7.96-31.54+0.5*264=622.44m3Q22级湿陷、换填2米,每边宽出基础周边0.8米,挖深6米深。围墙内场坪高出自然地面0.5米。V=840.25-195-58.23-7.96-31.54+0.5*264=679.52m3Q33级湿陷、换填3米,每边宽出基础周边1米,挖深7米深。围墙内场坪高出自然地面0.5米。V=1011-291-58.23-7.96-31.54+0.5*264=754.27m39、接地装置安装矩形柱:0.7*4*3.2*4=35.84tf接地扁钢:-40mm*4mm74米接地角钢:50mm*5mm24米V=(9.3*9.3-0.7*0.7*4)*0.3=25.359m330米四管塔基础工程量1、场地平整:S=16*16.5=2642、基础土方开挖及换填Q2级湿陷、换填2米,每边宽出基础周边0.8米,挖深5.5米深。V=1/3(7.2*7.2+14.5*14.5+7.2*14.5)*5.5=671.9m33:7灰土换填:V=1/3(7.2*7.2+9.8*9.8+7.2*9.8)*2=145.6m33、基础垫层砼:C155.9*5.9*0.1=3.48m3基础底板砼:C305.6*5.6*0.8=25.09m3矩形柱砼:C300.7*0.7*2.7*4=5.29m3连系梁砼:C301.9*0.4*0.6*4=1.84m34、现浇构件钢筋:圆钢W100.24t现浇构件钢筋:螺纹钢综合2.26t预埋铁件:0.58t5、模板安拆:基础垫层:5.9*4*0.1=2.36tf基础底板:5.6*4*0.8=17.92tf矩形柱:0.7*4*2.7*4=30.24tf连系梁:(1.9*0.6*2+1.9*0.4)*4=12.16tf6、连系梁下底、侧面灰渣回填(300厚)V=4.1*4.1*0.3=5.04m37、硬化面下换填...
