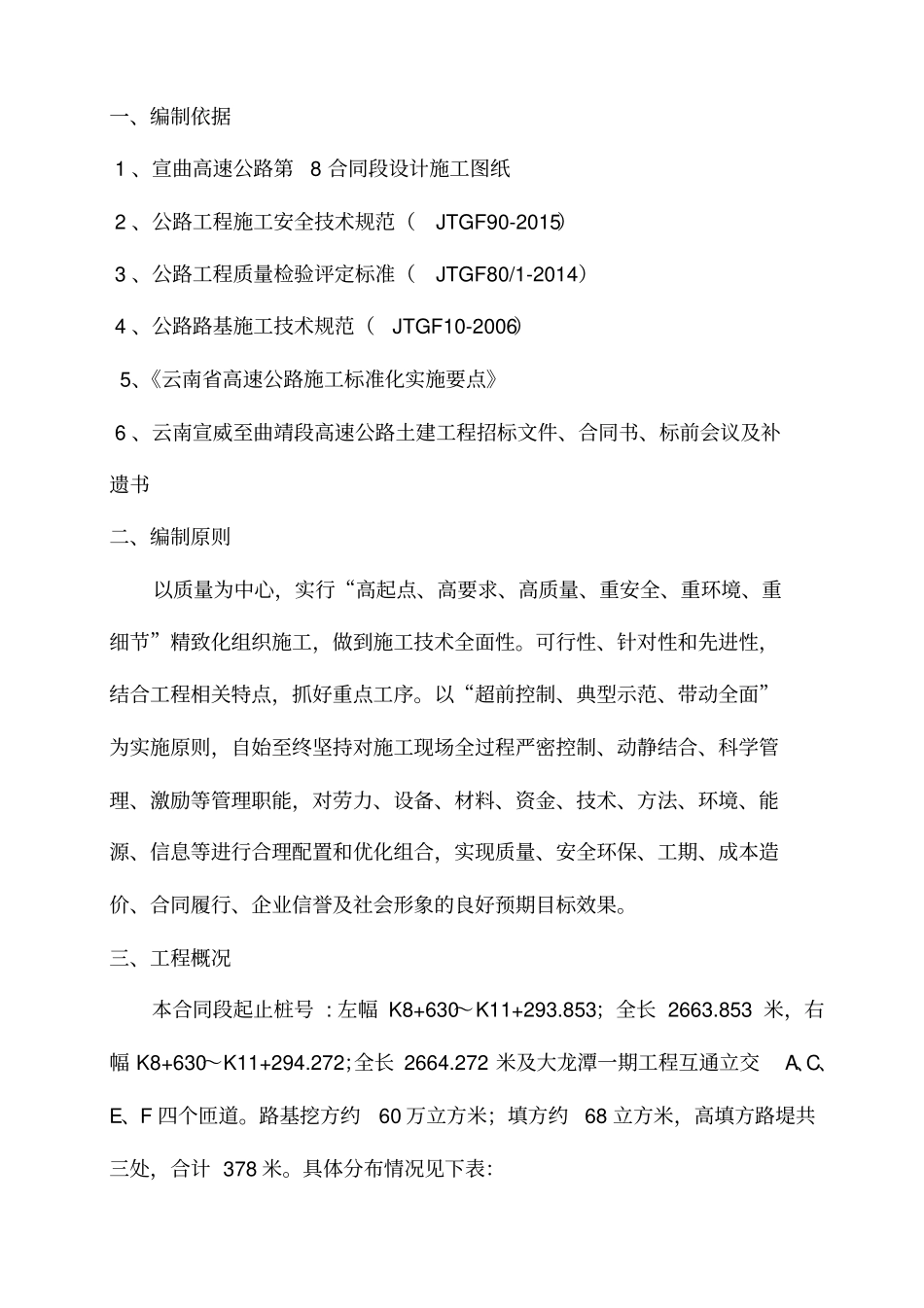

G56杭州至瑞丽高速公路宣威至曲靖段G60连接线(K8+630~K11+294段)高填方路基专项施工方案编制:复核:批准:中交路桥技术有限公司宣曲高速公路项目经理部二分部二○一五年十月目录一、编制依据···················································1二、编制原则···················································1三、工程概况···················································1四、施工准备、部署·············································2熟悉图纸和线路调查········································2······················································2······················································2五、主要施工工艺和方法·········································3施工工艺流程图············································4··················································4··················································5··················································6········································8··············································9············································9··············································10六、施工工期安排···············································10七、人员、材料、设备进场计划、资源安排·························11··············································11··················································11··················································12八、资金计划···················································12九、质量、安全、环保保证体系···································12········································12········································16········································199.4环境保护、水土保持措施····································22十、雨季施工保证措施···········································25·················································25·································25·················································26十一、质量控制及试验检测项目、频率和方法······················...
