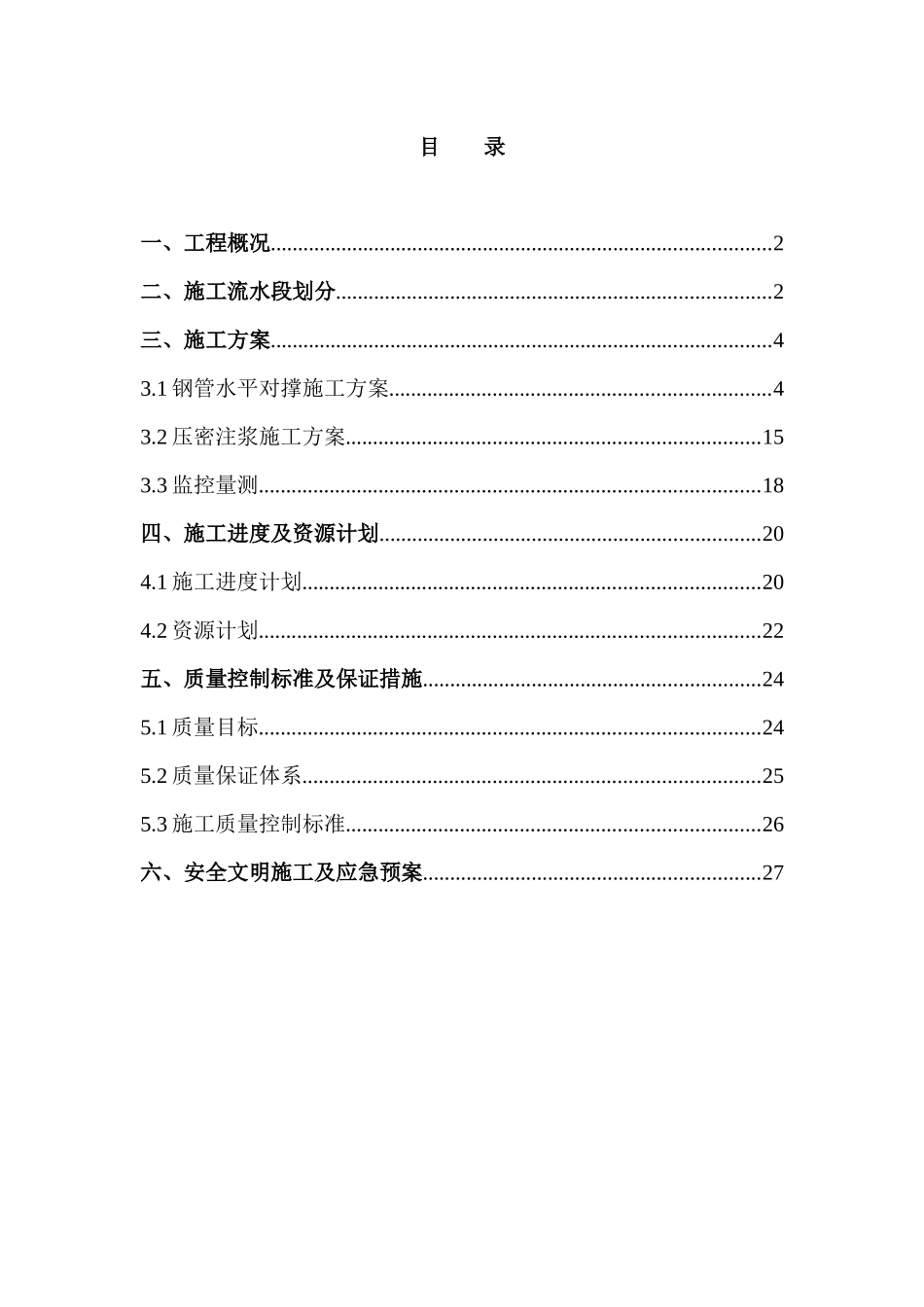

目 录一、工程概况............................................................................................2二、施工流水段划分................................................................................2三、施工方案............................................................................................43.1 钢管水平对撑施工方案......................................................................43.2 压密注浆施工方案............................................................................153.3 监控量测............................................................................................18四、施工进度及资源计划......................................................................204.1 施工进度计划....................................................................................204.2 资源计划............................................................................................22五、质量控制标准及保证措施..............................................................245.1 质量目标............................................................................................245.2 质量保证体系....................................................................................255.3 施工质量控制标准............................................................................26六、安全文明施工及应急预案..............................................................27中铁大酒店及机关南区 57#住宅楼工程深基坑支护设计变更施工方案一、工程概况中铁大酒店及机关南区 57#住宅楼深基坑目前开挖深度约-9.0 米因基坑东侧变形值超过设计变形预警值,且东侧东华公司餐厅局部及主楼西侧停车位由于地下水流失,造成沉降引起餐厅墙面开裂,故设计做出针对性方案变更。变形超预警后,已采取应急处理措施对东侧支护进行堆土反压,堆土高度为 5 米,堆土顶部高程约 26.50米下底宽 7.5 米,上口宽约 3.5 米。应急处理过后,深基坑支护变形已稳定。设计变更概况如下:分别在负一层顶、负二层顶设置两排钢管水平对撑,对撑间距 4 米,与地下车库主体连接,利用地库主体刚度抵抗基坑变形。地下室主体施...
