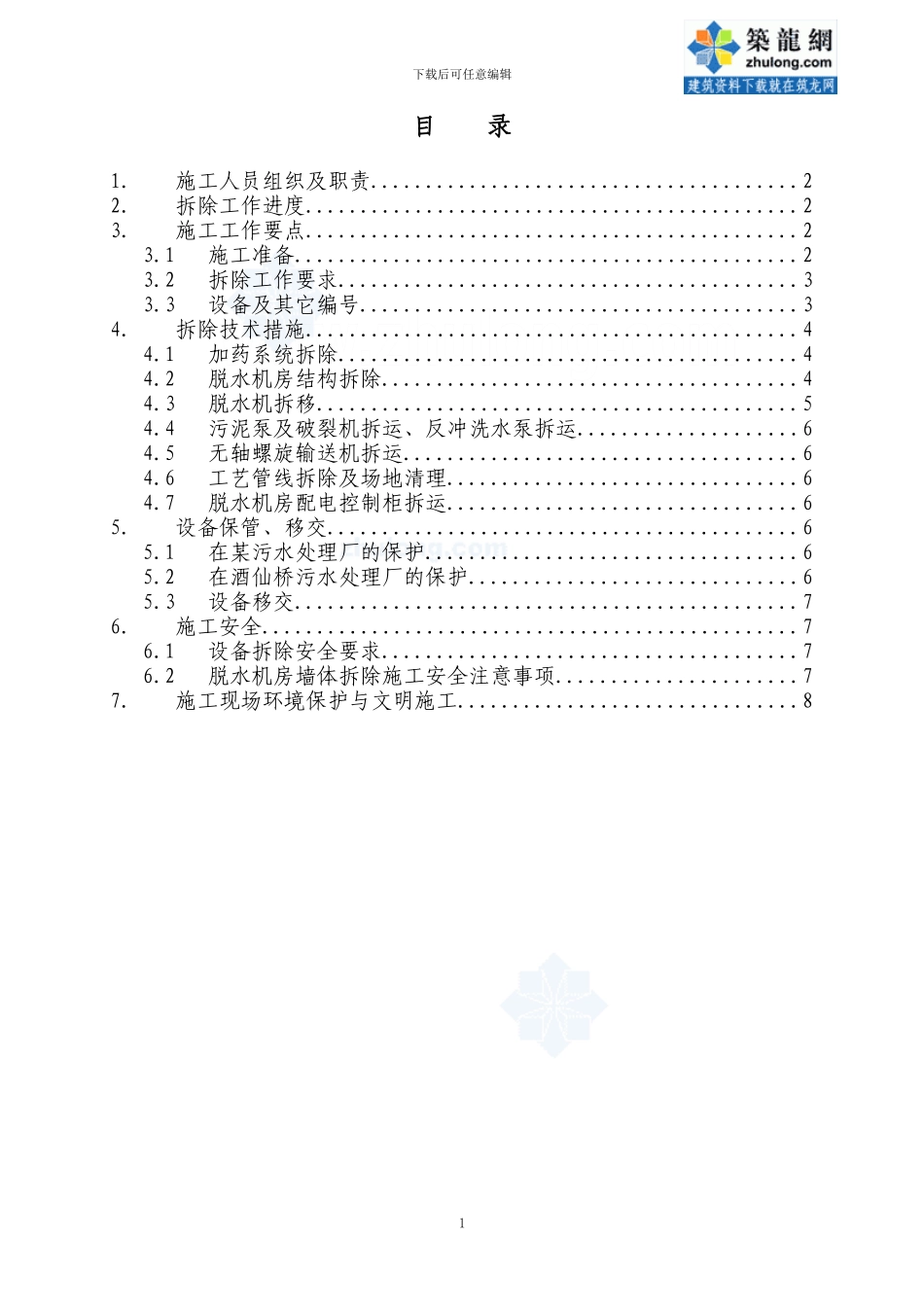

筑龙网给排水栏目所有资料免费下载了!!!污水处理厂脱水机房原有设备拆除方案二零零五年一月下载后可任意编辑目 录1.施工人员组织及职责.......................................22.拆除工作进度.............................................23.施工工作要点.............................................23.1施工准备..............................................23.2拆除工作要求..........................................33.3设备及其它编号........................................34.拆除技术措施.............................................44.1加药系统拆除..........................................44.2脱水机房结构拆除......................................44.3脱水机拆移............................................54.4污泥泵及破裂机拆运、反冲洗水泵拆运....................64.5无轴螺旋输送机拆运....................................64.6工艺管线拆除及场地清理................................64.7脱水机房配电控制柜拆运................................65.设备保管、移交...........................................65.1在某污水处理厂的保护..................................65.2在酒仙桥污水处理厂的保护..............................65.3设备移交..............................................76.施工安全.................................................76.1设备拆除安全要求......................................76.2脱水机房墙体拆除施工安全注意事项......................77.施工现场环境保护与文明施工...............................81下载后可任意编辑1.施工人员组织及职责为了保证某污水处理厂脱水机房原有设备能顺利拆除并及时运走,我公司由以下人员现场负责本工作:2.拆除工作进度⑴2005 年 1 月 7 日~9 日——拆除准备阶段① 自控仪表系统标识② 电气系统标识③ 脱水机房将拆移设备标识④ 协调调度人员及运输设备⑤ 准备脱水机拆除移位的材料、工具、设备⑥ 脱水机房现有供暖设施调整,脱水机房结构部分拆除,形成脱水机运输通道⑵2005 年 1 月 10 日~11 日——加药系统拆除① 拆运加药罐② 拆运稳压罐⑶2005 年 1 月 13 日~27 日——脱水机拆移① 将所有连接管道与脱水机分离(含污水、污泥、中水、电气、自控等)——1 月 13 日~14...
