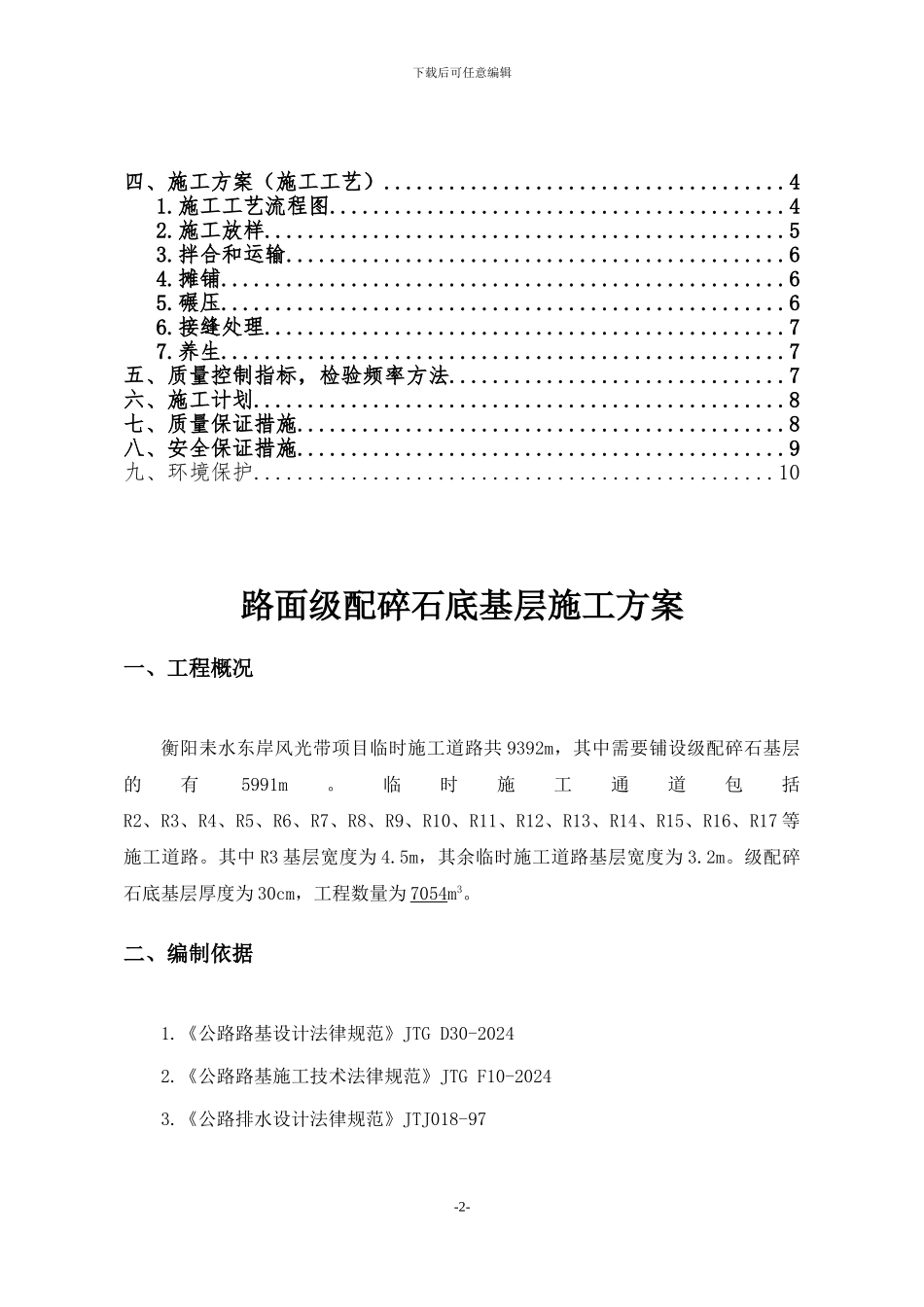

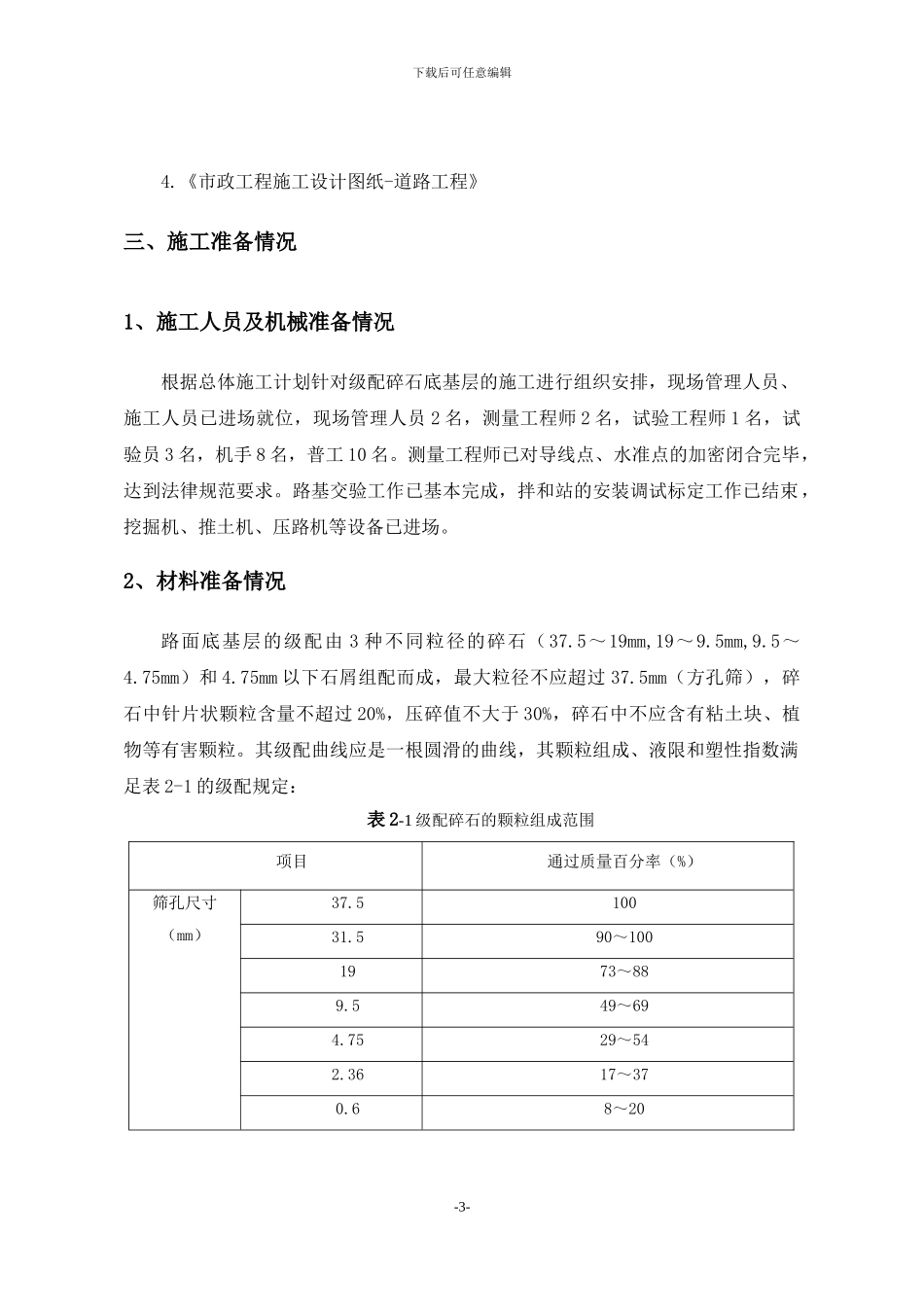

衡阳市耒水东岸风光带工程级配碎石基层施工方案审批: 审核: 编写: 中国水电第八工程局有限公司衡阳市耒水东岸风光带工程项目部二 O 一三年十二月二十三日一、工程概况.................................................3二、编制依据.................................................3三、施工准备情况.............................................31、施工人员及机械准备情况.................................32、材料准备情况...........................................4下载后可任意编辑四、施工方案(施工工艺).....................................41.施工工艺流程图..........................................42.施工放样................................................53.拌合和运输..............................................64.摊铺....................................................65.碾压....................................................66.接缝处理................................................77.养生....................................................7五、质量控制指标,检验频率方法...............................7六、施工计划.................................................8七、质量保证措施.............................................8八、安全保证措施.............................................9九、环境保护................................................10路面级配碎石底基层施工方案一、工程概况衡阳耒水东岸风光带项目临时施工道路共 9392m,其中需要铺设级配碎石基层的有5991m。临时施工通道包括R2、R3、R4、R5、R6、R7、R8、R9、R10、R11、R12、R13、R14、R15、R16、R17 等施工道路。其中 R3 基层宽度为 4.5m,其余临时施工道路基层宽度为 3.2m。级配碎石底基层厚度为 30cm,工程数量为 7054m3。二、编制依据1.《公路路基设计法律规范》JTG D30-20242.《公路路基施工技术法律规范》JTG F10-20243.《公路排水设计法律规范》JTJ018-97-2-下载后可任意编辑4.《市政工程施工设计图纸-道路工程》三、施工准备情况1、施工人员及机械准备情况根据总体施工计划针对级配碎石底基层的施工进行组织安排,现场管理人员、施工人员已进场就位,现场管理人员 2 名,测量工程师 2 名,试验工程师 1 名,试验员 3 名,机手 8 名,普工 10 名。...
