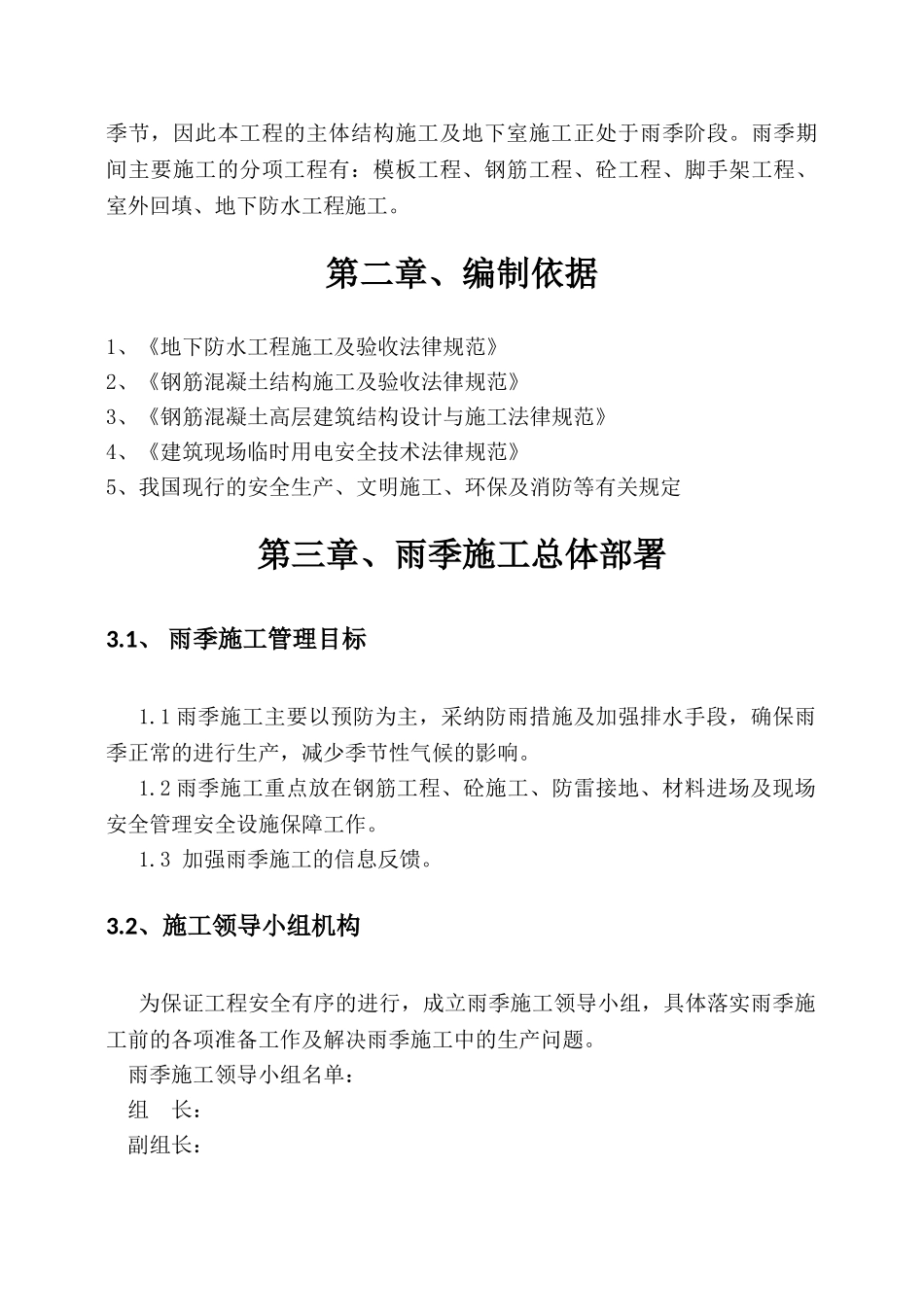

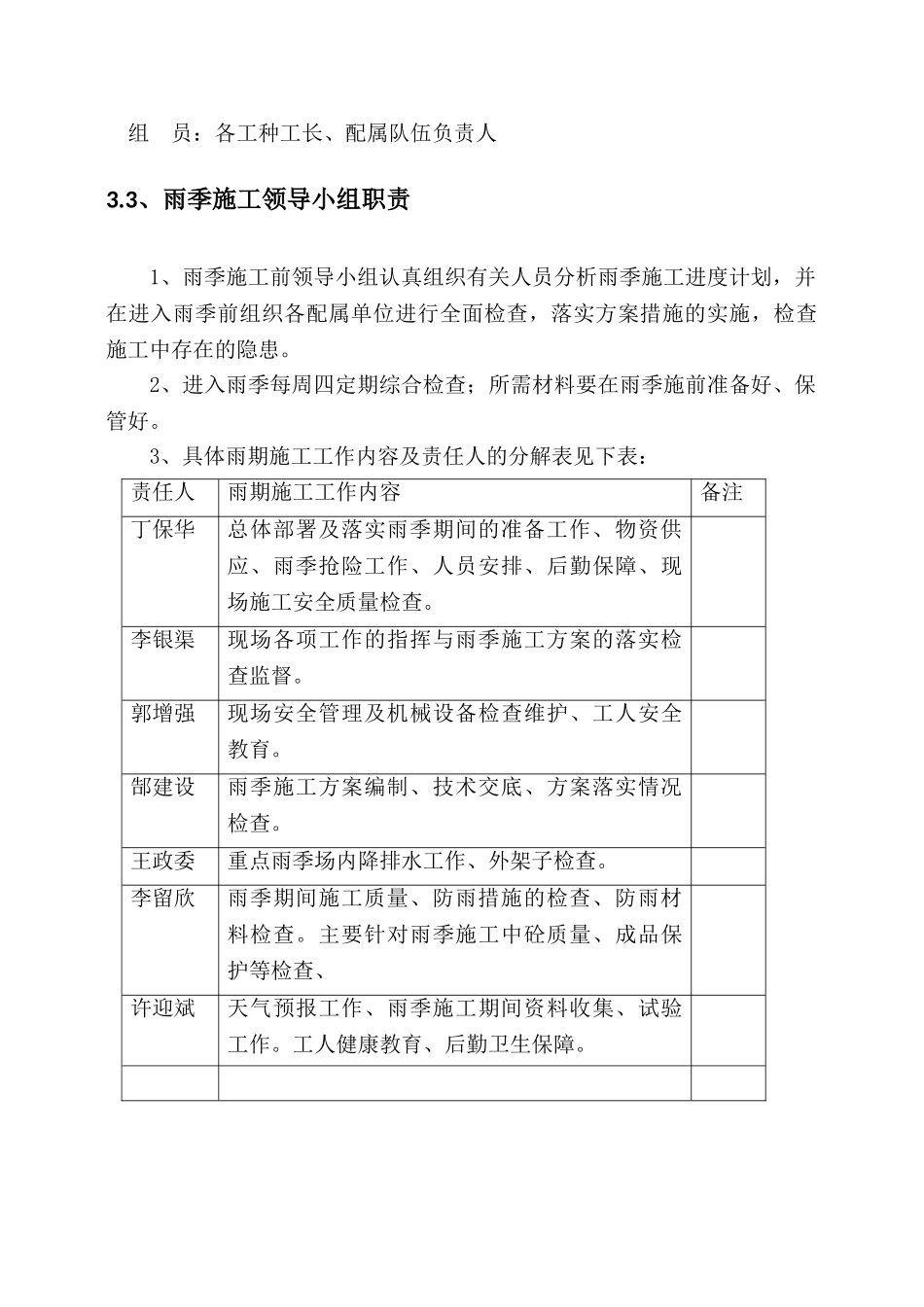

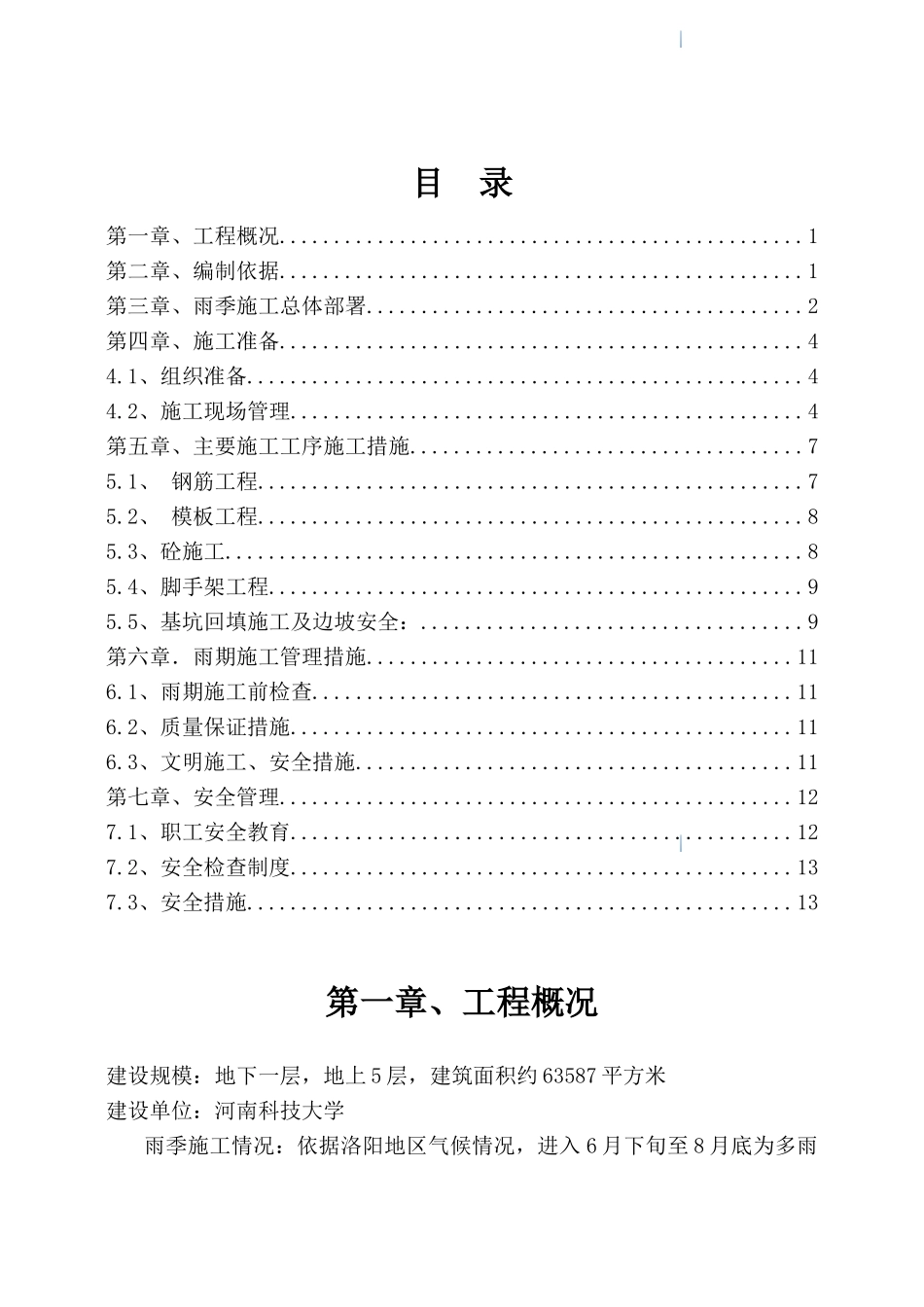

目 录第一章、工程概况................................................1第二章、编制依据................................................1第三章、雨季施工总体部署........................................2第四章、施工准备................................................44.1、组织准备...................................................44.2、施工现场管理...............................................4第五章、主要施工工序施工措施....................................75.1、 钢筋工程..................................................75.2、 模板工程..................................................85.3、砼施工.....................................................85.4、脚手架工程.................................................95.5、基坑回填施工及边坡安全:...................................9第六章.雨期施工管理措施.......................................116.1、雨期施工前检查............................................116.2、质量保证措施..............................................116.3、文明施工、安全措施........................................11第七章、安全管理...............................................127.1、职工安全教育..............................................127.2、安全检查制度..............................................137.3、安全措施..................................................13第一章、工程概况建设规模:地下一层,地上 5 层,建筑面积约 63587 平方米建设单位:河南科技大学 雨季施工情况:依据洛阳地区气候情况,进入 6 月下旬至 8 月底为多雨季节,因此本工程的主体结构施工及地下室施工正处于雨季阶段。雨季期间主要施工的分项工程有:模板工程、钢筋工程、砼工程、脚手架工程、室外回填、地下防水工程施工。第二章、编制依据1、《地下防水工程施工及验收法律规范》 2、《钢筋混凝土结构施工及验收法律规范》 3、《钢筋混凝土高层建筑结构设计与施工法律规范》4、《建筑现场临时用电安全技术法律规范》 5、我国现行的安全生产、文明施工、环保及消防等有关规定第三章、雨季施工总体部署3.1、 雨季施工管理目标1.1 雨季施工主要以预防为主,采纳防雨措施及加强排水手段,确保雨季正常的进行生产,减...
