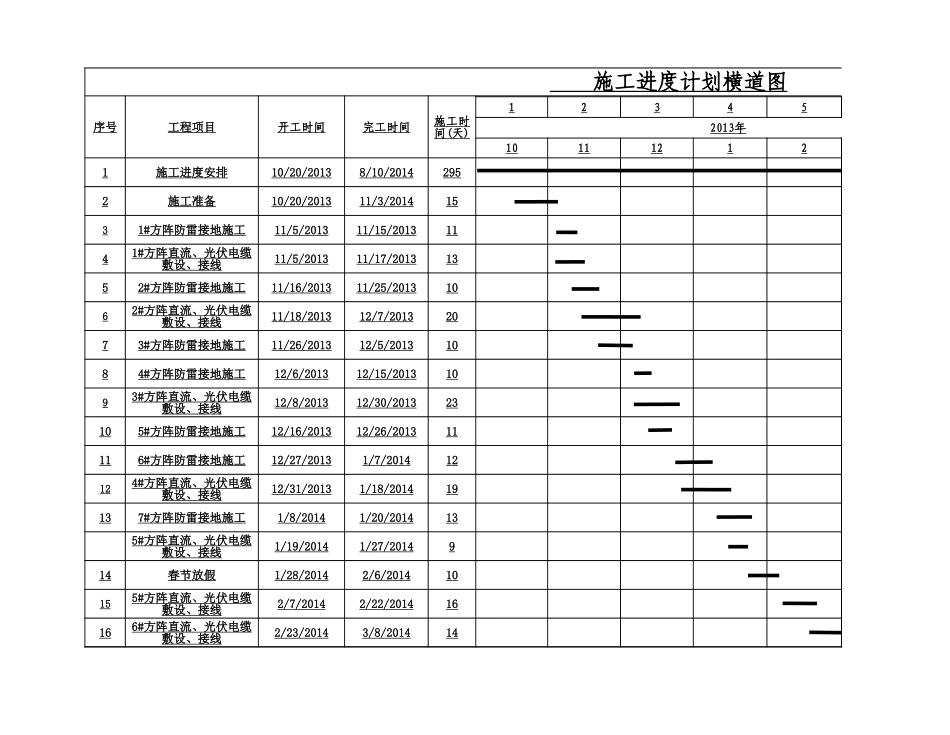

施工进度计划横道图序号工程项目开工时间完工时间12345101112121施工进度安排10/20/20138/10/20142952施工准备10/20/201311/3/201415311/5/201311/15/201311411/5/201311/17/201313511/16/201311/25/201310611/18/201312/7/201320711/26/201312/5/201310812/6/201312/15/201310912/8/201312/30/2013231012/16/201312/26/2013111112/27/20131/7/2014121212/31/20131/18/201419131/8/20141/20/2014131/19/20141/27/2014914春节放假1/28/20142/6/201410152/7/20142/22/201416162/23/20143/8/201414施工时间(天)2013年1#方阵防雷接地施工1#方阵直流、光伏电缆敷设、接线2#方阵防雷接地施工2#方阵直流、光伏电缆敷设、接线3#方阵防雷接地施工4#方阵防雷接地施工3#方阵直流、光伏电缆敷设、接线5#方阵防雷接地施工6#方阵防雷接地施工4#方阵直流、光伏电缆敷设、接线7#方阵防雷接地施工5#方阵直流、光伏电缆敷设、接线5#方阵直流、光伏电缆敷设、接线6#方阵直流、光伏电缆敷设、接线172/14/20142/26/201413183/9/20143/29/201421192/27/20143/11/201413203/12/20143/24/201413213/30/20144/19/201421223/25/20144/5/201412234/20/20145/10/201421244/6/20144/19/201414254/20/2014
