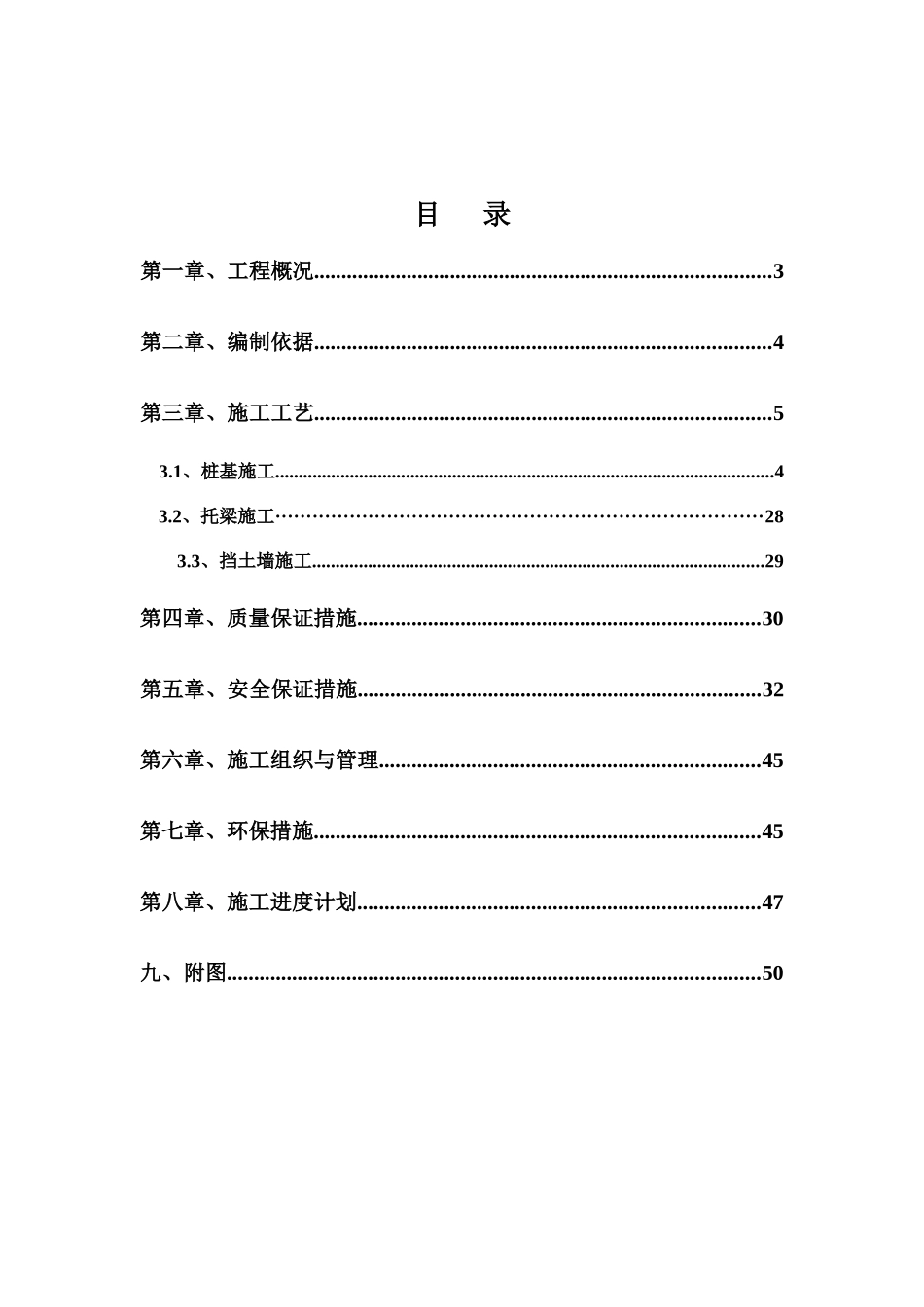

西区产业园起步区工程西创路(原新普路)桩基托梁挡土墙工程施工专项方案编制人:审核人:审批人:中建股份有限公司西区产业园起步区项目部2024 年 2 月目 录第一章、工程概况....................................................................................3第二章、编制依据....................................................................................4第三章、施工工艺....................................................................................5 3.1、桩基施工...........................................................................................................4 3.2、托梁施工··············································································283.3、挡土墙施工.................................................................................................29第四章、质量保证措施..........................................................................30第五章、安全保证措施..........................................................................32第六章、施工组织与管理......................................................................45第七章、环保措施..................................................................................45第八章、施工进度计划..........................................................................47九、附图..................................................................................................50第一章 工程概况 1.1 工程简介本工程为天府新区西区产业园起步区“两纵一横”建设项目西创路位于新津县新普路,起于滨河路中桥,止于中储粮兴物六路全长 7000 米。K5+369-K5+419 段右侧桩基托梁挡土墙全长 50 米,桩基为双排桩梅花形布置,桩长 19 米、桩径 1.2 米,设计强度 C30,共 20 根桩。托梁每片长 10 米、宽 4.5 米、高1.0 米。采纳 C30 混凝土。挡土墙强身采纳 C15 混凝土。K5+369-K5+419 段右侧原设计为原道路加宽填筑路堤拆除酒精库围墙,现将此段方案调整为 K5+369-K5+419 段右侧桩基托梁挡土墙。方案作出调整前我司按原设计填筑方案施工,现...
