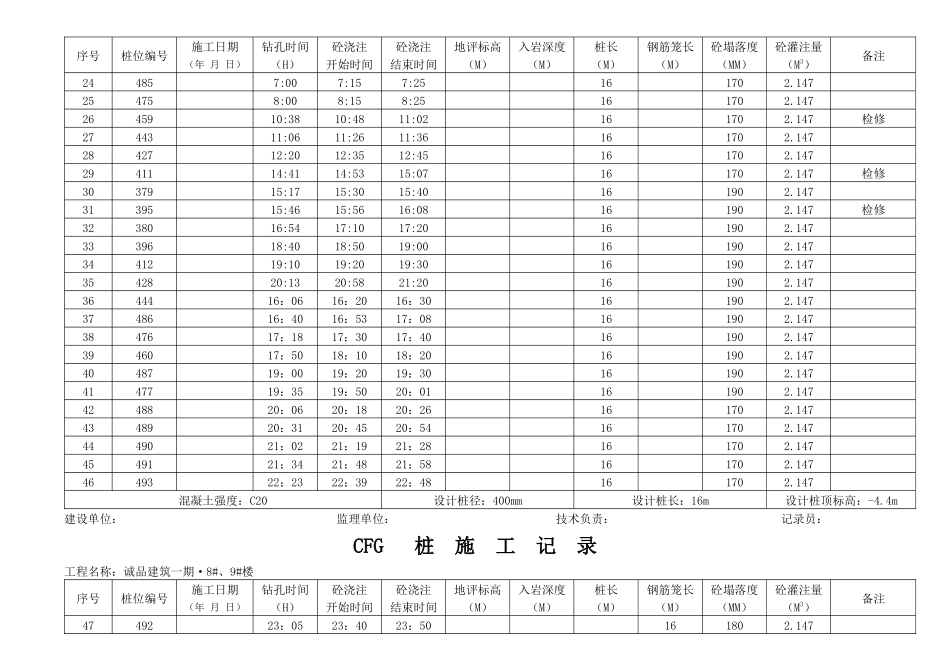

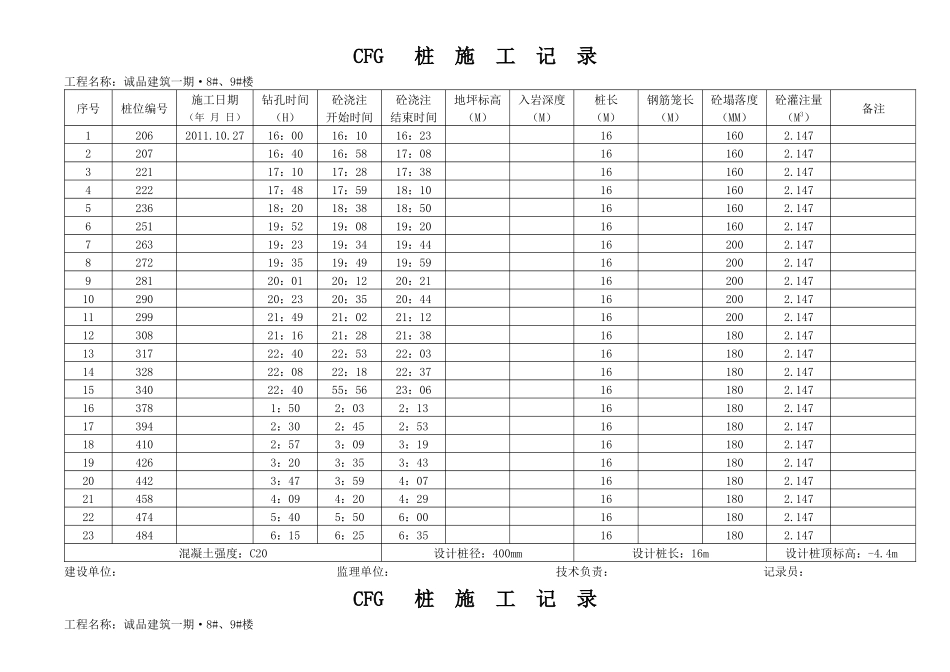

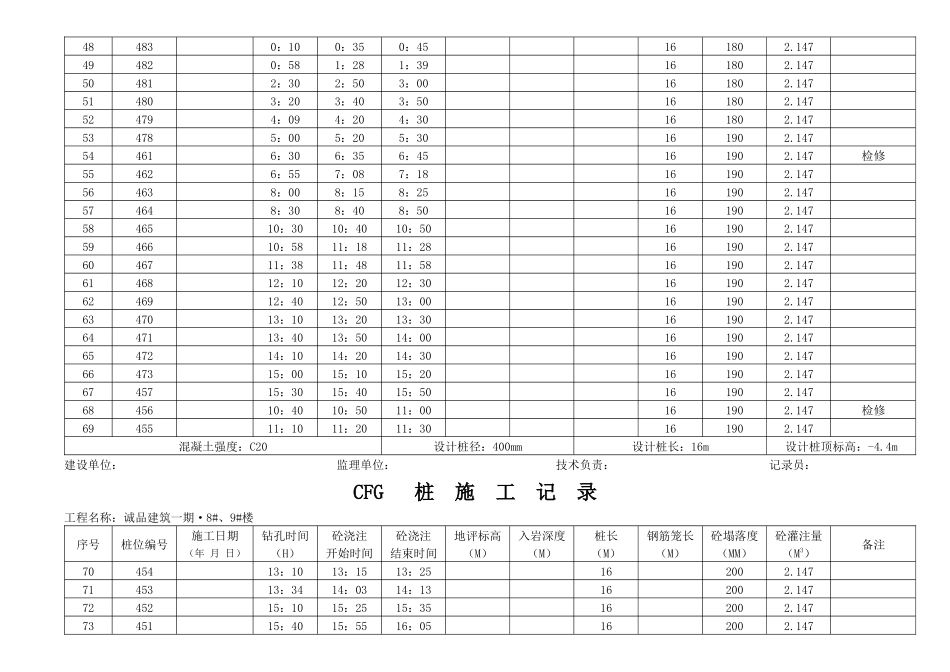

CFG 桩 施 工 记 录工程名称:诚品建筑一期·8#、9#楼 序号桩位编号施工日期(年 月 日)钻孔时间(H)砼浇注开始时间砼浇注结束时间地坪标高(M)入岩深度(M)桩长(M)钢筋笼长(M)砼塌落度(MM)砼灌注量(M3)备注12062011
2716:0016:1016:23161602
147220716:4016:5817:08161602
147322117:1017:2817:38161602
147422217:4817:5918:10161602
147523618:2018:3818:50161602
147625119:5219:0819:20161602
147726319:2319:3419:44162002
147827219:3519:4919:59162002
147928120:0120:1220:21162002
1471029020:2320:3520:44162002
1471129921:4921:0221:12162002
1471230821:1621:2821:38161802
1471331722:4022:5322:03161802
1471432822:0822:1822:37161802
1471534022:4055:5623:06161802
147163781:502:032:13161802
147173942:302:452:53161802
147184102:573:093:19161802
147194263:203:353:43161802
147204423:473:594:07161802
147214584:094:204:29161802
147224745:405:506:00161802
147234846:156:256:35161802
147混凝土强度:C20设计桩径:400mm
