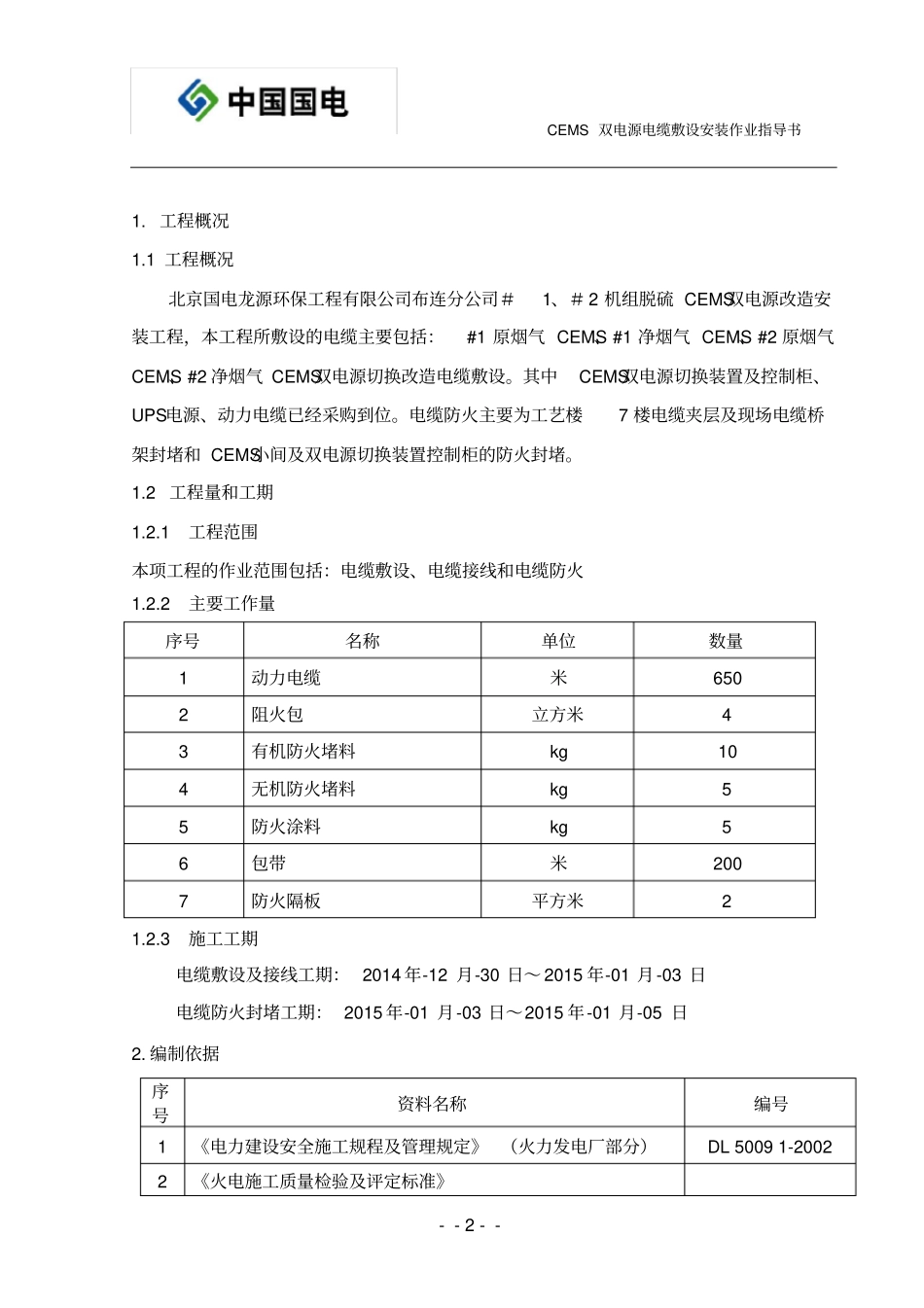

北京国电龙源环保工程有限公司布连分公司#1、#2机组烟气脱硫装置CEMS双电源电缆敷设安装作业指导书批准:审核:编制:日期:北京国电龙源环保工程有限公司布连分公司CEMS双电源电缆敷设安装作业指导书--1--1.工程概况..............................................................................................................................................-2-1.1工程概况.....................................................................................................................................-2-1.2工程量和工期.............................................................................................................................-2-2.编制依据................................................................................................................................................-2-3.作业前的条件和准备.............................................................................................................................-3-3.1技术准备.....................................................................................................................................-3-3.3劳动力组织机构和人员要求.....................................................................................................-4-3.4作业工机具................................................................................................................................-5-3.5安全器具....................................................................................................................................-5-3.6工序交接....................................................................................................................................-5-3.7作业环境的要求..........................................................................................................................-5-4.作业程序和方法....................................................................................................................................-6-4.1作业程序的步骤流程..................................................................................................................-6-4.2电缆敷设施工方案......................................................................................................................-6-4.3电缆接线施工方案.....................................................................................................................-8-4.4电缆防火封堵施工方案..............................................................................................................-9-5.质量控制点的设置和质量通病预防.....................................................................................................-9-5.1质量目标.....................................................................................................................................-9-5.2质量通病及预防措施..................................................................................................................-9-5.2.1质量通病:......................................................................................................................-9-5.2.2预防措施.........................................................................................................................-9-5.3作业过程中控制点的设置.......................................................................................................-10-5...
