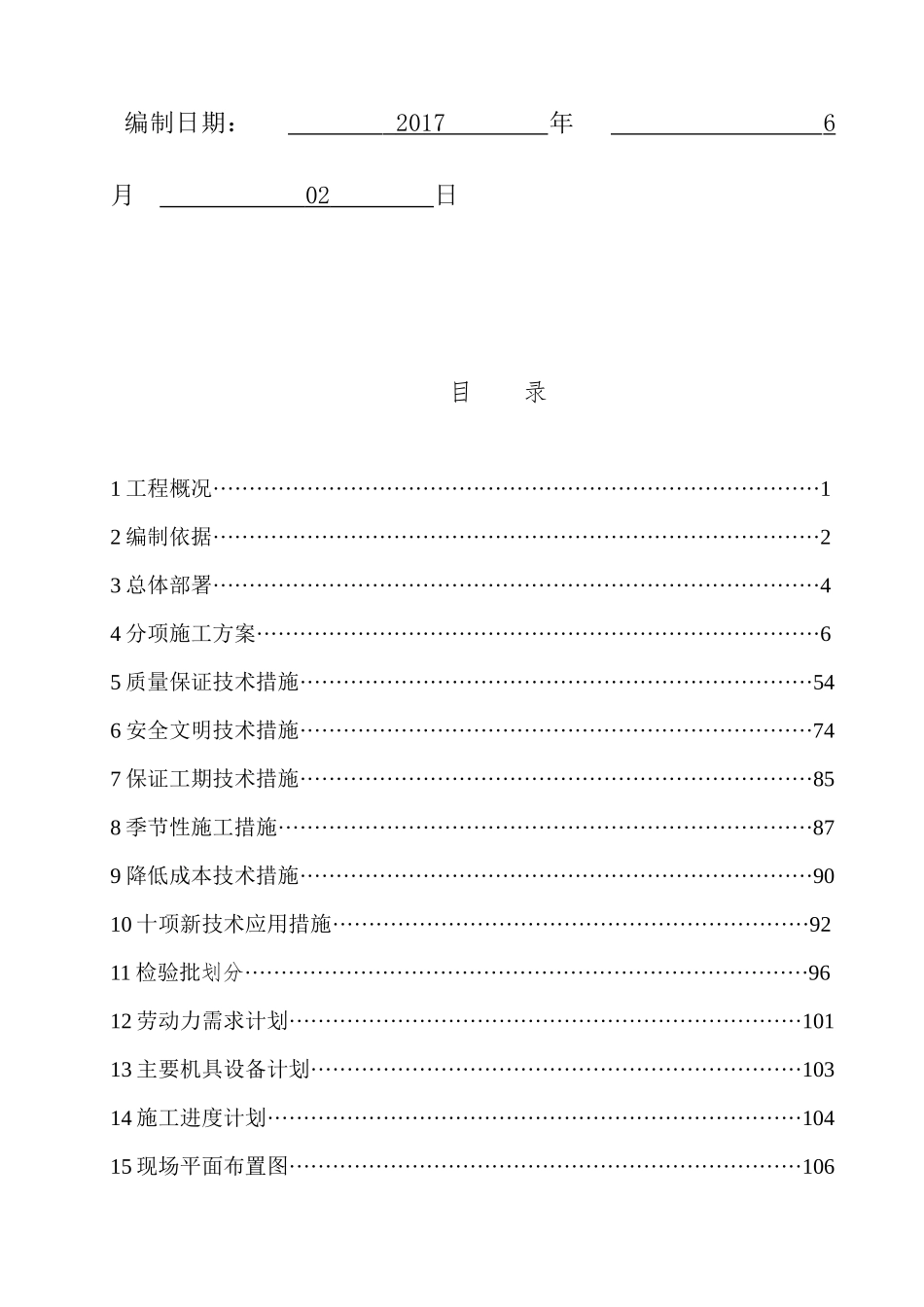

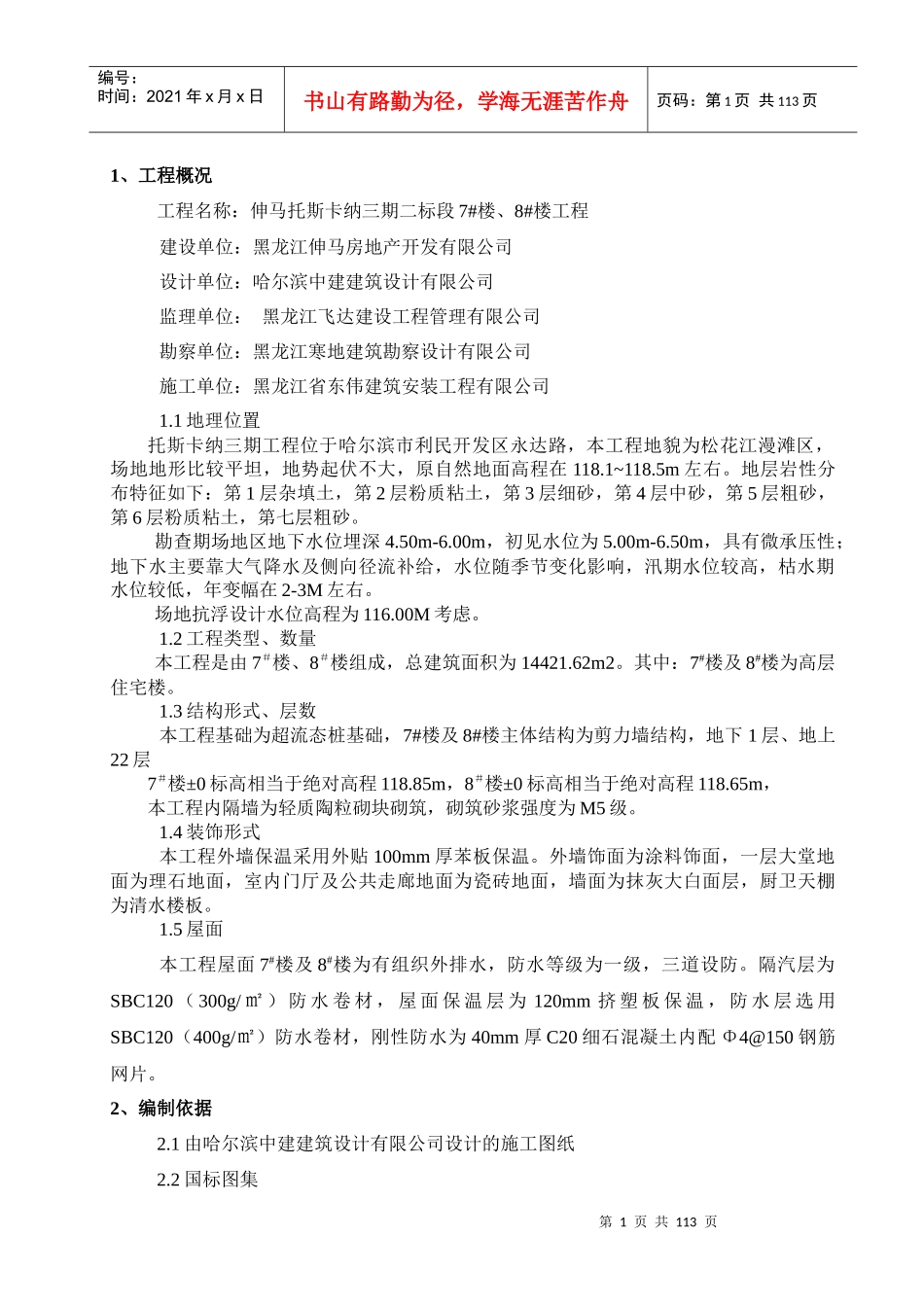

C2-01-1单位工程施工组织设计工程名称:伸马托斯卡纳三期二标段7#楼、8#楼工程施工单位:黑龙江省东伟建筑安装工程有限公司编制日期:2017年6月02日目录1工程概况····················································································12编制依据····················································································23总体部署····················································································44分项施工方案··············································································65质量保证技术措施·······································································546安全文明技术措施·······································································747保证工期技术措施·······································································858季节性施工措施··········································································879降低成本技术措施·························
