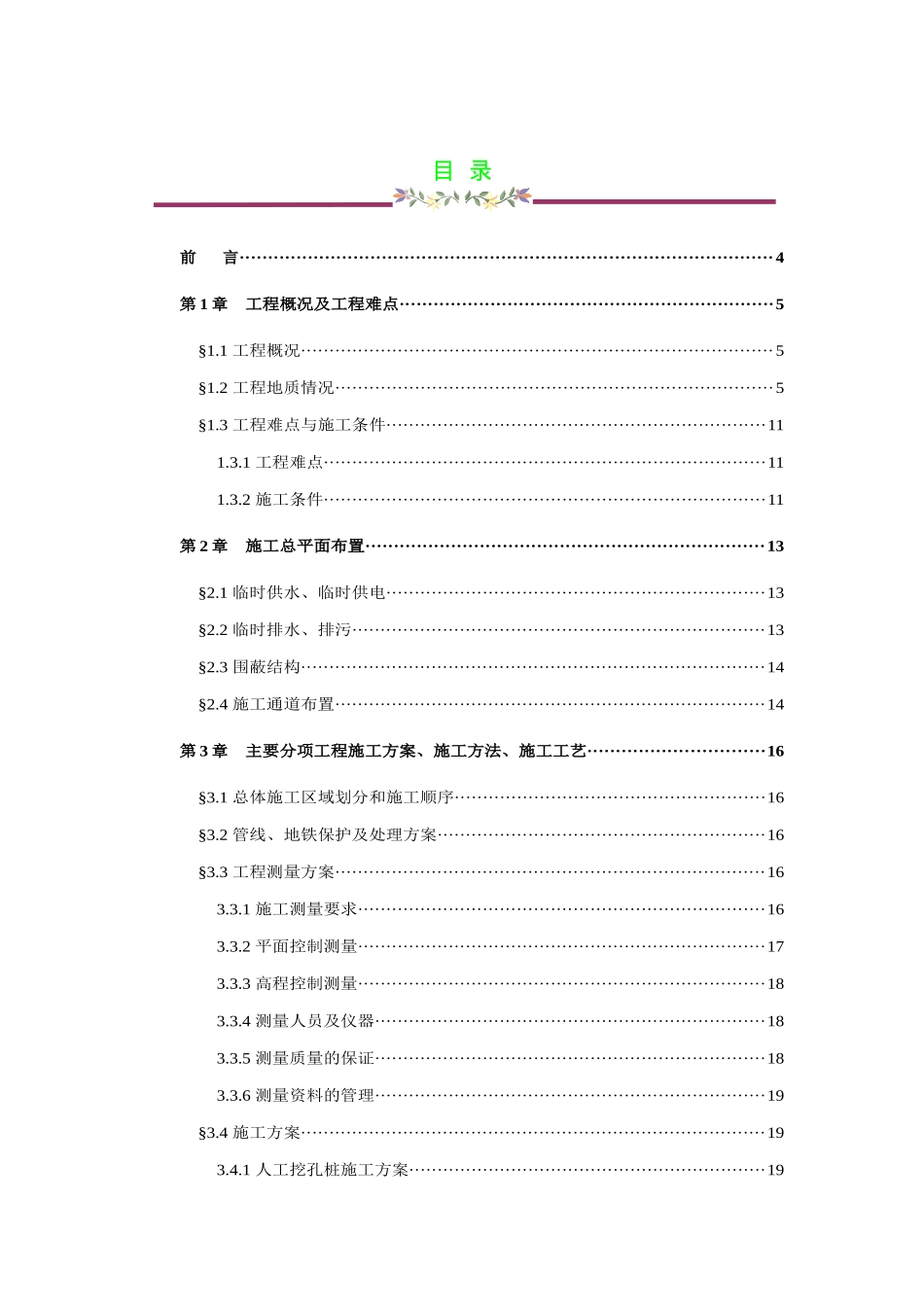

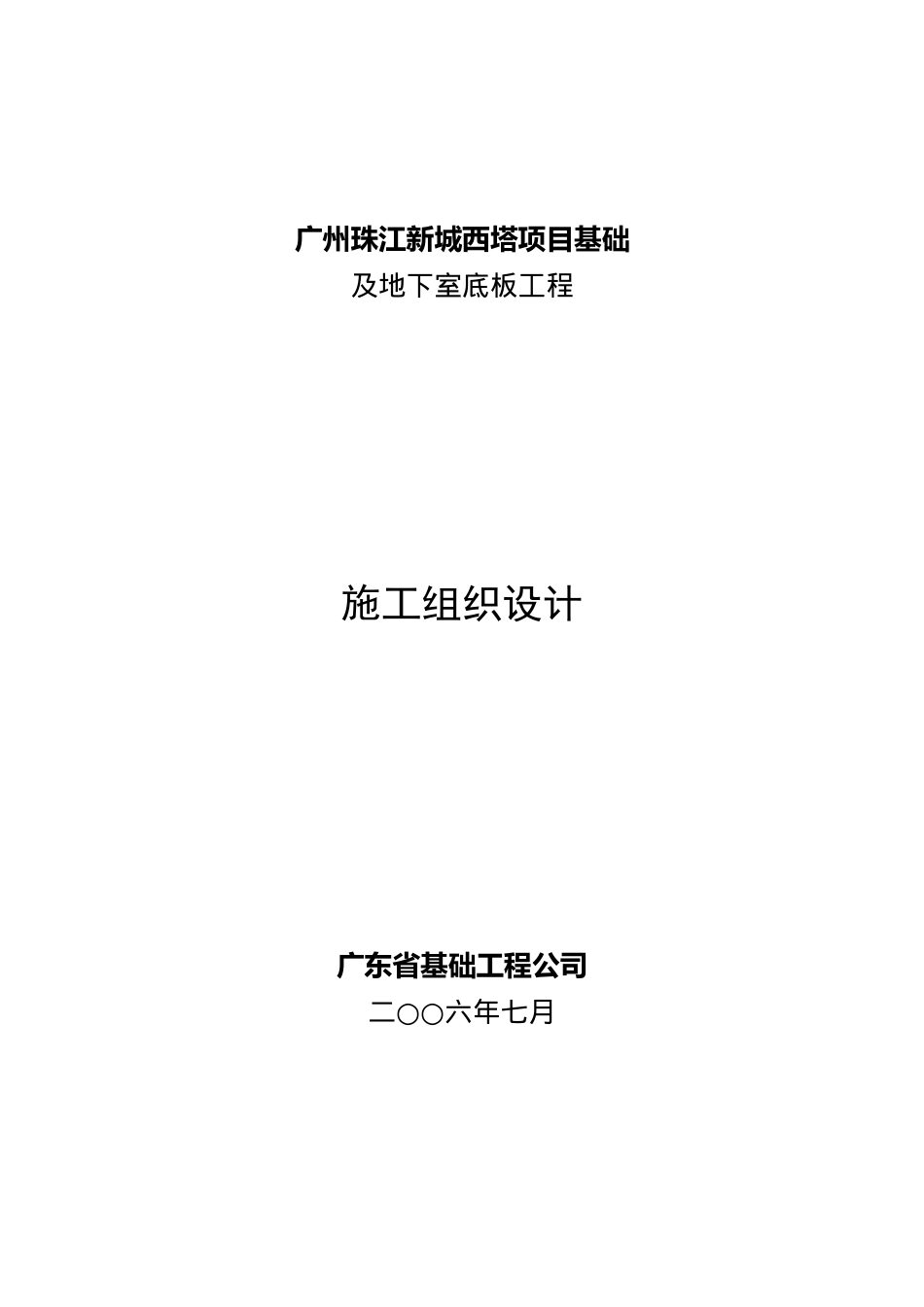

广州珠江新城西塔项目基础及地下室底板工程施工组织设计广东省基础工程公司○○二六年七月目 录前 言······························································································4第 1 章 工程概况及工程难点··································································5§1
1 工程概况···················································································5§1
2 工程地质情况·············································································5§1
3 工程难点与施工条件···································································111
1 工程难点··············································································111
2 施工条件··············································································11第 2 章 施工总平面布置······································································13§2
1 临时供水、临时供电·······························
