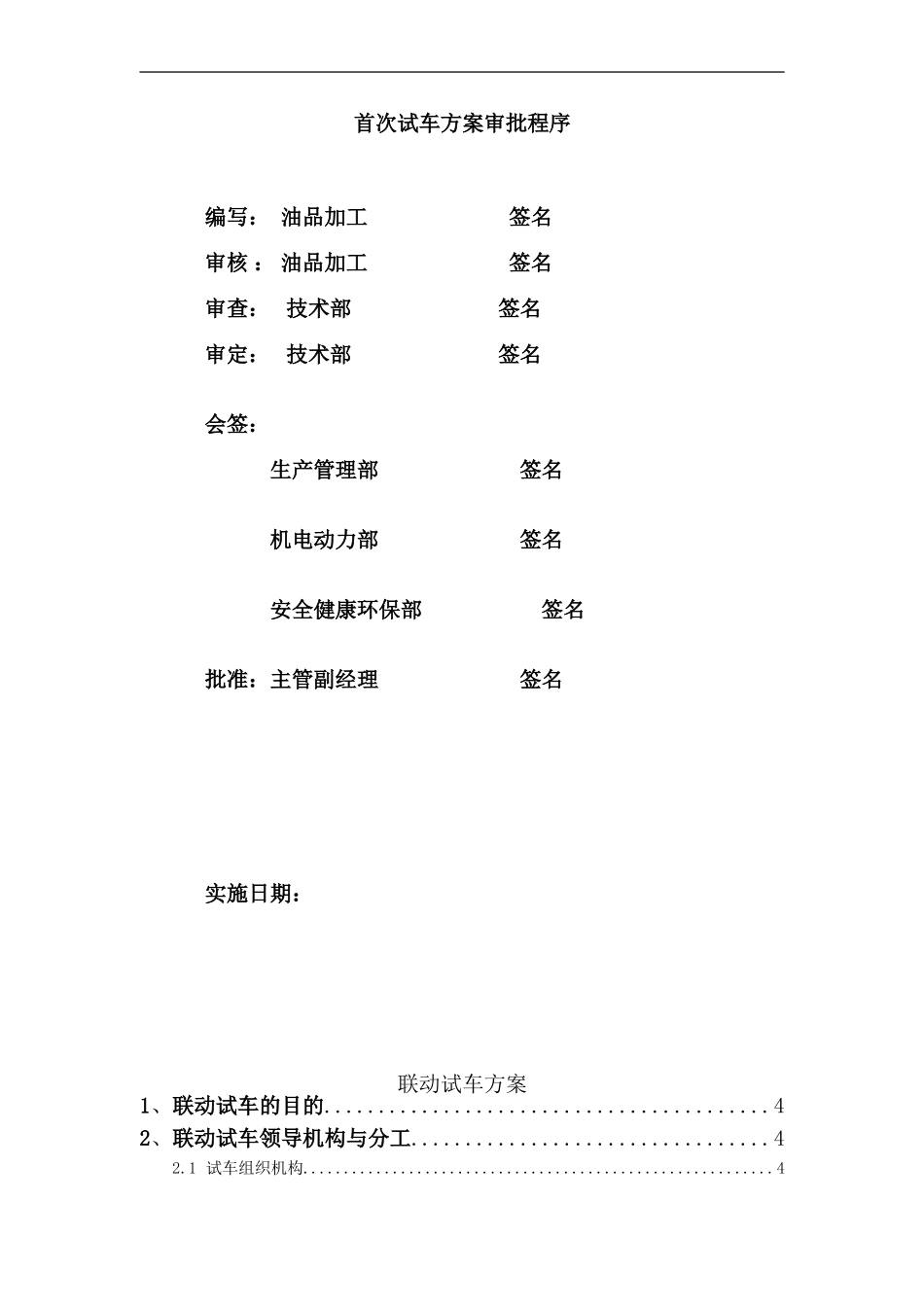

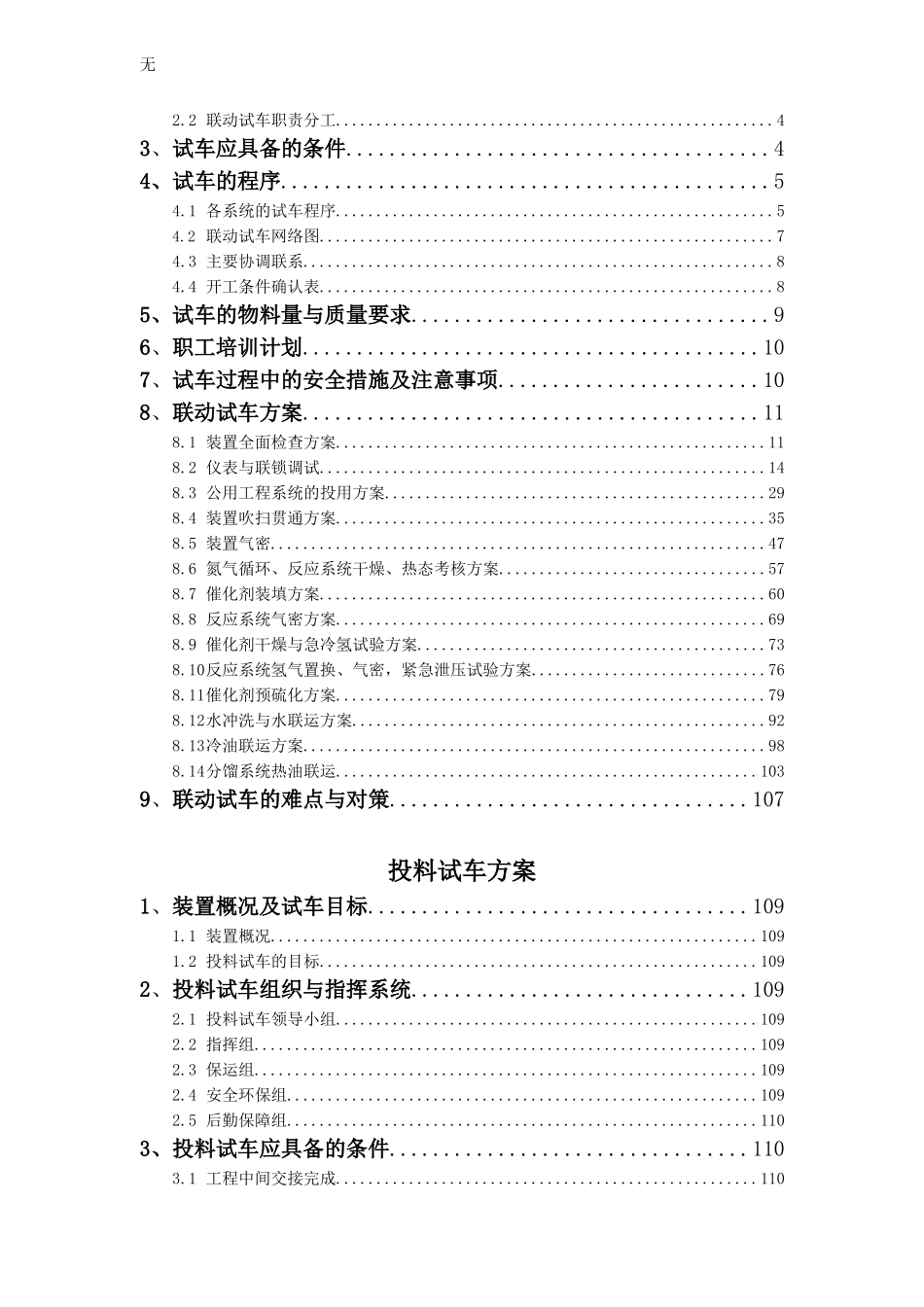

编号:加氢装置首次试车方案(初稿)内蒙古伊泰化工有限责任公司油品加工装置二○一四年七月首次试车方案审批程序编写:油品加工签名审核:油品加工签名审查:技术部签名审定:技术部签名会签:生产管理部签名机电动力部签名安全健康环保部签名批准:主管副经理签名实施日期:联动试车方案1、联动试车的目的.........................................42、联动试车领导机构与分工.................................42.1试车组织机构..........................................................4无2.2联动试车职责分工......................................................43、试车应具备的条件.......................................44、试车的程序.............................................54.1各系统的试车程序......................................................54.2联动试车网络图........................................................74.3主要协调联系..........................................................84.4开工条件确认表........................................................85、试车的物料量与质量要求.................................96、职工培训计划..........................................107、试车过程中的安全措施及注意事项........................108、联动试车方案..........................................118.1装置全面检查方案.....................................................118.2仪表与联锁调试.......................................................148.3公用工程系统的投用方案...............................................298.4装置吹扫贯通方案.....................................................358.5装置气密.............................................................478.6氮气循环、反应系统干燥、热态考核方案.................................578.7催化剂装填方案.......................................................608.8反应系统气密方案.....................................................698.9催化剂干燥与急冷氢试验方案...........................................738.10反应系统氢气置换、气密,紧急泄压试验方案.............................768.11催化剂预硫化方案.....................................................798.12水冲洗与水联运方案...................................................928.13冷油联运方案.........................................................988.14分馏系统热油联运....................................................1039、联动试车的难点与对策.................................107投料试车方案1、装置概况及试车目标...................................1091.1装置概况............................................................1091.2投料试车的目标......................................................1092、投料试车组织与指挥系统...............................1092.1投料试车领导小组....................................................1092.2指挥组..............................................................1092.3保运组..............................................................1092.4安全环保组..........................................................1092.5后勤保障组..........................................................1103、投料试车应具备的条件.................................1103.1工程中间交接完成....................................................110无3.2联动试车已完成......................................................1103.3人员培训已完成......................................................1103.4各项生产管理制度已落实..............................................1103.5经上级批准的投料试车方案已向生产人员...
