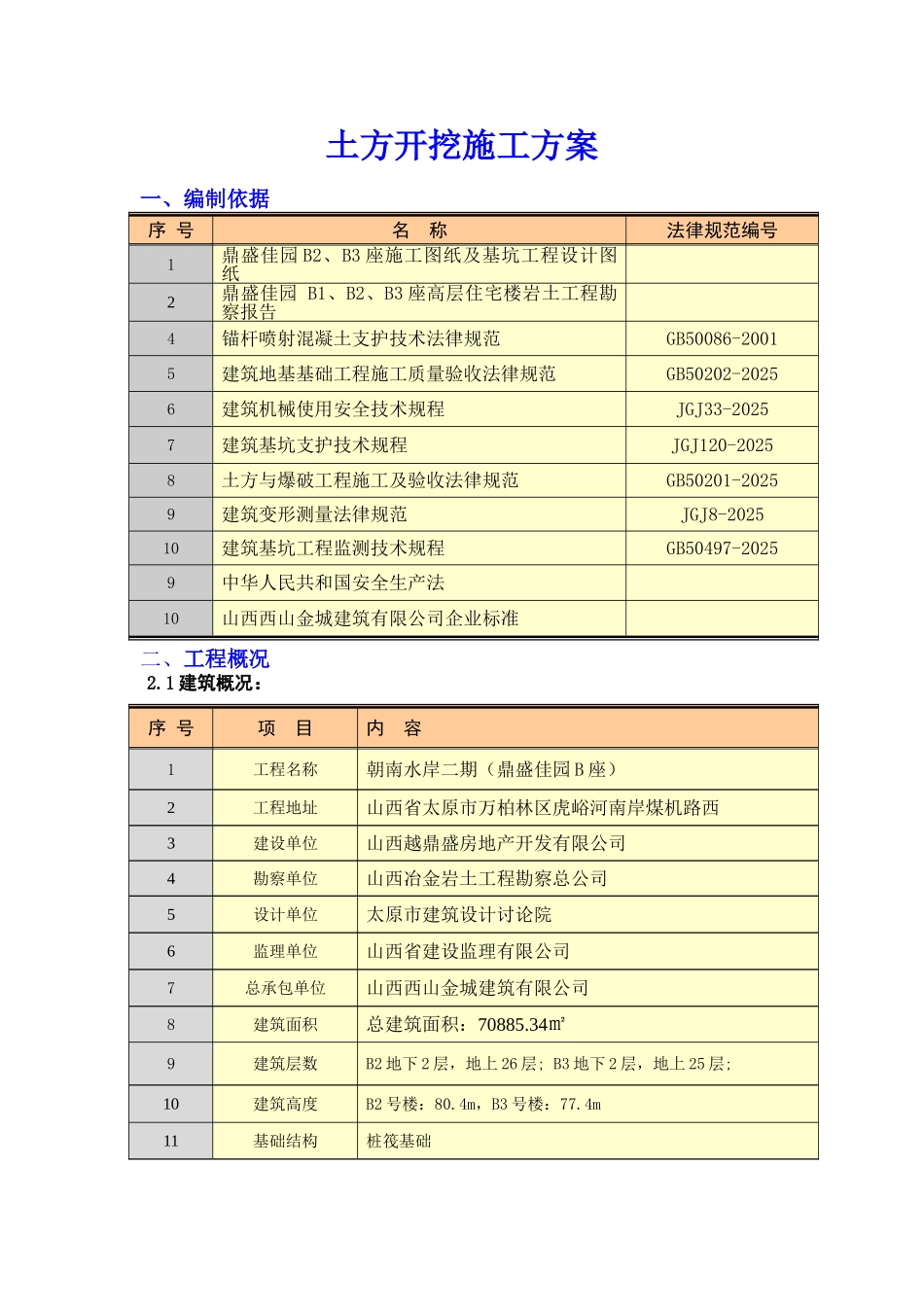

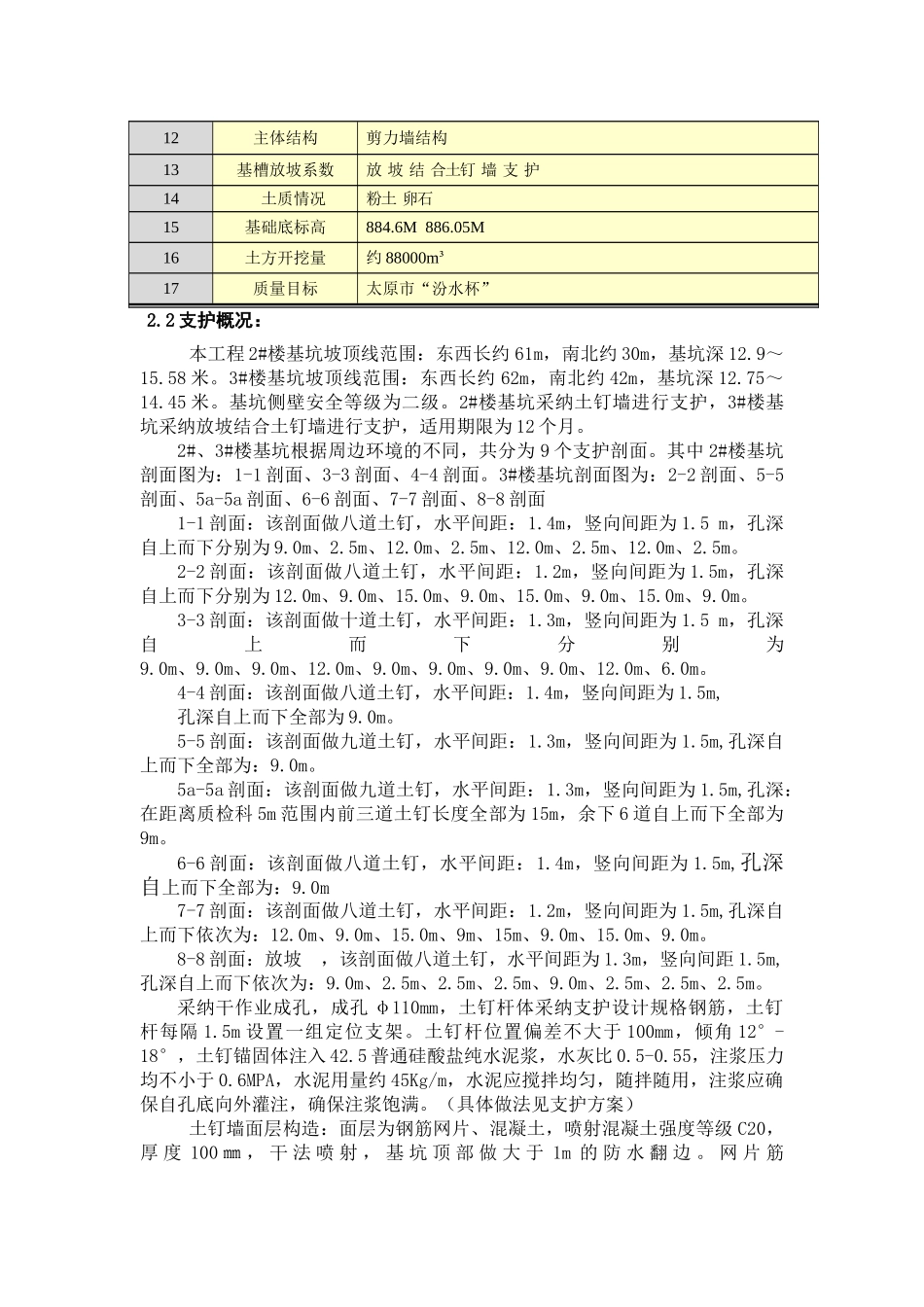

目 录一、编制依据:....................................1二、工程概况:....................................12.1 建筑概况:...................................................12.2 现场概况:...................................................2三、施工准备:....................................33.1 施工现场准备:...............................................33.2 技术准备:...................................................33.3 基础土方开挖顺序图:.........................................53.4 土方开挖计划:...............................................53.5 主要施工机械准备:...........................................53.6 劳动力安排准备:.............................................63.7 施工管理体系图:.............................................6四、主要工序控制措施:..............................7五、施工工艺及方法:................................75.1 土方开挖顺序:...............................................75.2 具体施工方法:...............................................75.3 基坑变形观测措施:...........................................85.4 土方施工过程中注意事项:.....................................9六、质量要求和质量保证措施:..........................106.1 土方开挖质量要求:..........................................106.2 质量保证措施:..............................................10七、成品保护措施:................................11八、安全技术措施:................................11九、环境卫生及职业健康保护措施:.......................12十、突发情况的预防和应急、抢险措施:....................1210.1 突发情况的分析:...........................................1210.2 突发情况的预防:...........................................1210.3 突发情况的应急处置措施:...................................13土方开挖施工方案一、编制依据二、工程概况2.1 建筑概况:序 号项 目内 容1工程名称朝南水岸二期(鼎盛佳园 B 座)2工程地址山西省太原市万柏林区虎峪河南岸煤机路西3建设单位山西越鼎盛房地产开发有限公司4勘察单位山西冶金岩土工程勘察总公司5设计单位太原市建筑...
