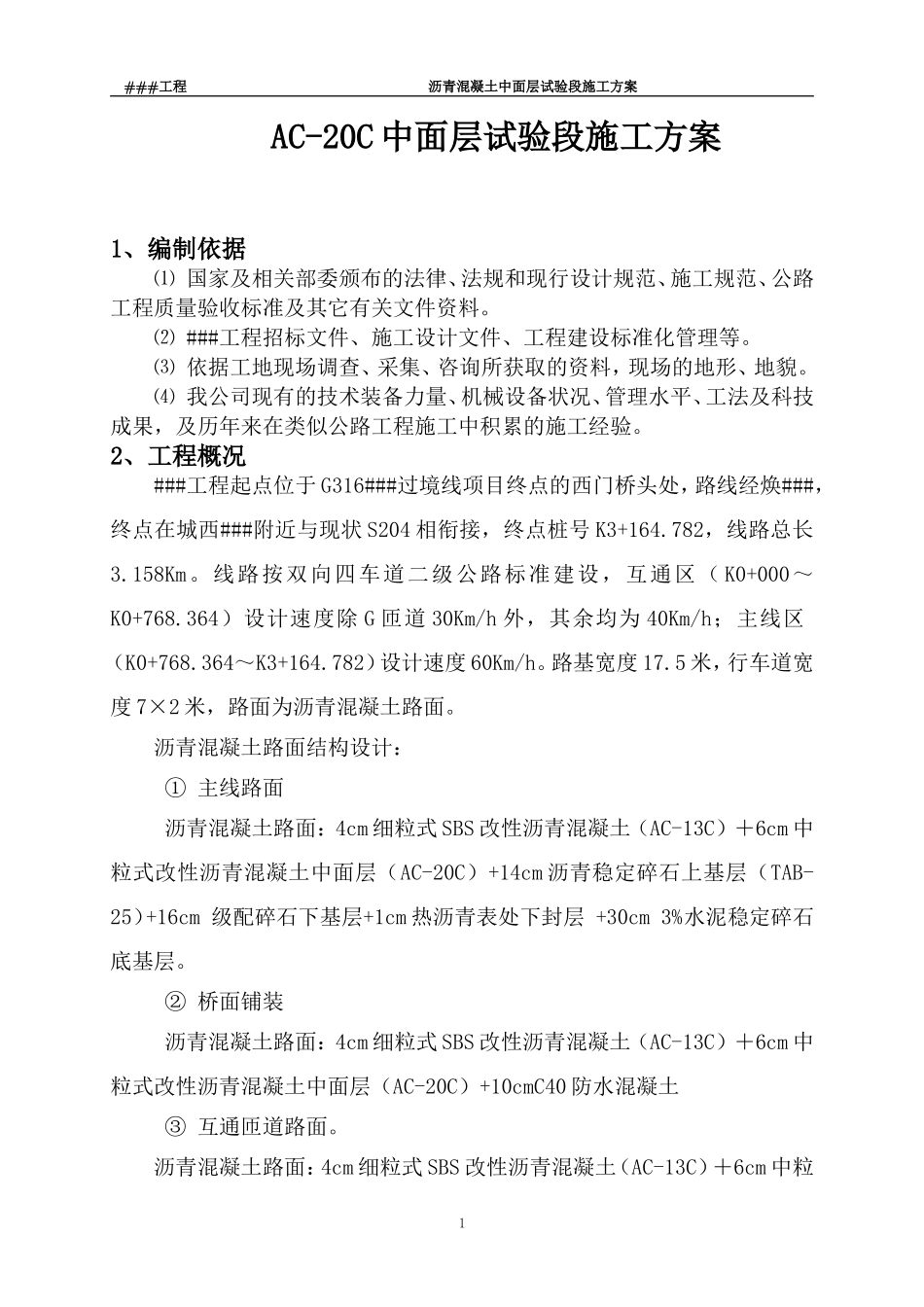

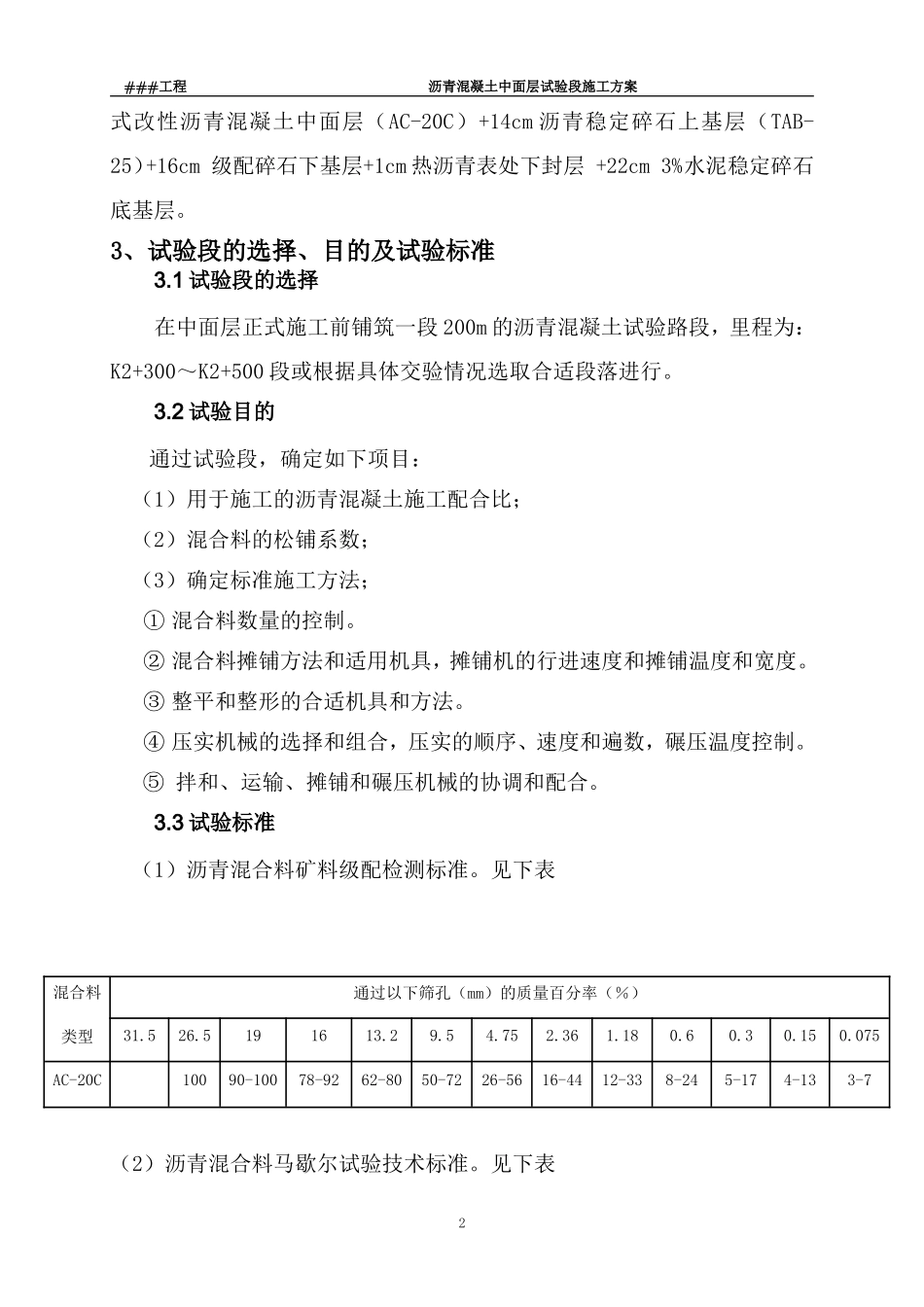

目 录1、编制依据...................................................12、工程概况...................................................13、试验段的选择、目的及试验标准...............................23.1 试验段的选择..........................................23.2 试验目的..............................................23.3 试验标准..............................................23、施工组织...................................................43.1 施工组织机构..........................................43.2 劳动力组织............................................53.3 机械设备..............................................64、施工方案...................................................64.1 施工准备..............................................64.2 沥青混合料的运输......................................74.3 沥青混合料的摊铺......................................74.4 沥青混合料的碾压......................................84.5 接缝处理..............................................94.6 试验段成果总结.......................................115、质量保证措施..............................................116、安全保证体系及措施........................................137、文明施工及环境保护措施....................................167.1 文明施工保证措施.....................................167.2 环境保护措施.........................................171###工程 沥青混凝土中面层试验段施工方案AC-20C 中面层试验段施工方案1、编制依据⑴ 国家及相关部委颁布的法律、法规和现行设计规范、施工规范、公路工程质量验收标准及其它有关文件资料。⑵ ###工程招标文件、施工设计文件、工程建设标准化管理等。⑶ 依据工地现场调查、采集、咨询所获取的资料,现场的地形、地貌。⑷ 我公司现有的技术装备力量、机械设备状况、管理水平、工法及科技成果,及历年来在类似公路工程施工中积累的施工经验。2、工程概况###工程起点位于 G316###过境线项目终点的西门桥头处,路线经焕###,终点在城西###附近与现状 S204 相衔接,终点桩号 K3+164.782,线路总长3.158Km。线路按双向四车道二级公路标准建设,互通区( K0+000~K0+768.364)设计速度除 G ...
